HUNGARY

(Updated 2022)

PREAMBLE AND SUMMARY

This report provides information on the status and development of nuclear power programmes in Hungary, including factors related to the effective planning, decision making and implementation of the nuclear power programme that together lead to the safe and economical operation of nuclear power plants (NPPs).

The CNPP summarizes organizational, industrial aspects of nuclear power programmes and provides information about the relevant legislative, regulatory and international framework in Hungary.

Hungary has one NPP with four units that provided half of electricity production in 2021, with one research reactor and one training reactor also in operation. Construction of two new NPP units is planned in order to maintain the capacity of the Paks NPP and to meet future electricity demand.

1. COUNTRY ENERGY OVERVIEW

1.1. ENERGY INFORMATION

1.1.1. Energy policy

In line with the European Union (EU) gas and electricity market directives, all electricity and gas customers have the ability to select their supplier freely as of 1 July 2007. In the same year, the Act on Electricity (Act No. 86 of 2007) was adopted by the Hungarian Parliament, supporting full liberalization of the electricity market in order to enhance economic competitiveness and to provide sustainable security of supply. The act is also harmonized with the requirements of the EU. Most provisions of the act entered into force in 2007. In the beginning of 2008, the electricity market was fully liberalized. The year 2008 was considered a transition period for the energy market, as players in the market adapted to new rules. Non-residential electricity consumers in Hungary pay for substantial subsidies to renewable sectors through levies on their tariffs. The new premium based renewable support scheme (METàR) was approved by the Hungarian Parliament in 2016 and introduced in 2017.

In February 2008, the National Climate Change Strategy for 2008-2025 was adopted by the Hungarian Parliament. Following a longer period of strategic planning and consultation, the Government of Hungary approved the new National Energy Strategy and National Energy and Climate Plan (through 2030, with an outlook up to 2040) in January 2020. The revised strategic framework is organized around three strategic pillars: clean, smart and affordable energy. While focusing on energy consumers, the most important strategic objectives include the climate friendly transformation of the energy sector, the further strengthening of security of supply and the promotion of innovation and economic development. The new strategy includes more than 40 strategic measures and foresees a reduction of 95% in greenhouse gas emissions by 2050 from the 1990 level (see Act XLIV of 2020 on Climate Protection, adopted by the Hungarian Parliament to reach net-zero targets by 2050.). Nuclear energy continues to be considered essential to sector integration and to the goal of reaching a climate neutral economy. The preservation of the nuclear generation capacity by the replacement of the existing units at the Paks NPP before the end of their lifetime is one of the key strategic measures, aiming for further decarbonization of the electricity sector.

In the case of Hungary, the new National Energy Strategy adopted by Parliament in 2020 - prepared in parallel with the NECP - and the Second National Climate Change Strategy (NCCS 2) are the key national documents in conformity with the climate and energy policy objectives and directions of the EU for the year 2030. The Second National Climate Change Strategy was adopted by Parliament by way of Decision No 23/2018 of 31 October 2018 of Parliament. Pursuant to the Second National Climate Change Strategy, adopted by Parliament by way of Decision No 23/2018 of 31 October 2018 of Parliament, relating to the 2018-2030 period and providing a projection of the period up to 2050, a gross GHG emission reduction of 52-85% should be achieved by 2050 over the figure for 1990. In addition to the National Decarbonisation Road Map, this strategy also contains the National Adaptation Strategy (NAS) and the Climate Partnership Awareness Raising Plan. Climate Change Action Plans-relating to three-year periods-are drawn up to fulfill objectives of the Second National Climate Change Strategy. The First Climate Change Action Plan-in effect up to 2020-aims to precisely define tasks determined by the short-term directions of action of the NCCS 2 and to prepare long-term measures. The Climate Change Action Plan determines the main areas of intervention by relying on the three pillars of mitigation, adaptation and raising awareness. The first plan will be followed by new ones every three years.

As a major step in the strategic framework, the new National Energy Strategy of 2020 provided a roadmap until 2030 and proposed a vision until 2050. Its main priorities were security of supply, competitiveness and sustainability. The most important strategic measures included progress in renewable energy integration, preservation of nuclear generation capacity by lifetime extension and potential new generation capacity, infrastructure and institutional development, and promotion of energy efficiency.

The strategy emphasized the need for increasing energy efficiency, energy savings and the use of renewable energies (including wind, solar, geothermic and biomass), and nuclear energy. The new energy policy was a resolution that aims to maintain a balance between security of supply, cost effectiveness, energy efficiency and protection of the environment. According to the resolution, the Government started preparing the decision on new nuclear capacity for the replacement of existing units. The resolution also stated that the Government should create the necessary conditions for implementation of the programmes aimed at the final disposal of radioactive waste, and that the Government should inform the Parliament on the implementation of the energy policy at least every two years and, in case of need, propose review of the policy.

According to the National Policy for the Management of Spent Fuel and Radioactive Waste adopted in April 2015 and revised in 2020 by the Parliament and the National Programme on the Management of Spent Fuel and Radioactive Waste approved by the Government in 2016, national development goals and objectives relating to spent nuclear fuel and radioactive waste include development of a national strategy for the back end of the fuel cycle, with due consideration to be given to various options; continuous extension of the Spent Fuel Interim Storage Facility (SFISF) in Paks; phased implementation of the geological investigation programme of the Boda Claystone Formation aiming at a future deep geological repository; ongoing implementation of the safety enhancement programme at the Radioactive Waste Treatment and Disposal Facility (RWTDF) in PUspokszilay as well as the extension of the National Radioactive Waste Repository (NRWR) in Bàtaapàti and optimization of its disposal concept.

Following the accident at the Fukushima Daiichi NPP, all European countries operating NPPs performed a targeted safety reassessment (TSR) - the so called stress test - to meet the request of the European Council. The TSR of the Paks NPP focused on topics specified by the European Nuclear Safety Regulators Group (ENSREG, www.ensreg.eu), which included issues corresponding to earthquakes, flooding and other external natural hazard factors; the loss of electric power supply and of ultimate heat sink or a combination of those; and severe accident management. In relation to the hazard factors, it was assessed whether the design basis of the plant was duly determined and whether there were sufficient reserves beyond design basis before severe damage occurred. Based on the final report of the Paks NPP submitted to the Hungarian Atomic Energy Authority (HAEA) for regulatory review, the HAEA agreed that the proposed tasks in the report be carried out to further improve plant safety and also identified a few additional options. Along with the detailed coverage of the topics specified by ENSREG, the HAEA also established that the national legal requirements for the safety of NPPs are in line with international standards and best practices. The HAEA submitted the national report with the results of the review to the European Commission at the end of 2011 and published it on its web site. Based on the results of the regulatory review of the TSR, the HAEA concluded that the design basis of the Paks NPP is adequate and complies with legal requirements and international practice. The safety systems and safety functions satisfy requirements of the design basis. After the last periodic safety review of the Paks NPP, specific safety enhancement measures were implemented, mainly to improve the plant's beyond design basis capabilities. These measures are fully in line with expectations of the TSR as well. It can be concluded that the Paks NPP is safe and no deficiency has occurred. The measures initiated by the last periodic safety review provide robust capabilities for the plant for successful management of severe situations as well. In addition to the positive findings, the TSR identified a number of options and measures to further enhance plant safety. The HAEA ordered the operator of the plant to develop a detailed programme by the end of the first half of 2012 in order to realize these options.

The National Action Plan of Hungary on the implementation of actions based upon the lessons learned from the accident at the Fukushima Daiichi NPP was adopted in December 2012. The National Action Plan was prepared in accordance with the recommendations of ENSREG. The implementation of the National Action Plan is currently in progress.

As of 31 December 2021, the status of the implementation of the National Action Plan at the Paks NPP is the following: out of 46 tasks, 41 were completed and 5 were rescheduled by the HAEA in the framework of the periodic safety review.

1.1.2. Estimated available energy

TABLE 1. ESTIMATED AVAILABLE ENERGY SOURCES

Fossil fuels Nuclear Renewables
Solid Liquid Gas Uranium Hydro Other
Total amount* 10 494.4 68.37 1667.5 31.8
Total amount in exajoules (EJ) 0.016 60.110

*Solid (coal), liquid - million tonnes; gas - billion m3; uranium ore - million tonnes.

Source: Fossil Fuels and Nuclear, 1 Jan. 2021: Supervisory Authority of Regulatory Affairs

In 2021, liquid (both crude oil and condensate) production was 0.89 million t. Hydrocarbon gas amounted to 1.66 billion m3. As of 1 January 2021, Hungary's estimated coal resources were nearly 10.5 billion t. The bulk of this resource is lignite, with 5.7 billion t, followed by 3.2 billion t of brown coal and 1.6 billion t of hard coal. Hungary produced about 4.9 million t of coal in 2021. Generally, the coal found in Hungary has low calorific value with high ash and sulphur content. The vast share of coal is used for power generation. In 1997, the uranium mine was closed and production ceased. Remediation activities at the site began the following year and were completed in 2008. Ongoing treatment of contaminated water from the mine and tailings ponds results in the collection of about 1-3 tU per year.

1.1.3. Energy Consumption Statistics

TABLE 2. ENERGY CONSUMPTION

Final Energy consumption [PJ] 2000 2005 2010 2015 2020 Compound
annual growth
rate 2000-2020 (%)
Total 730 865 803 798 836 0.68
Coal, Lignate and Peat 35 35 29 22 18 -3.36
Oil 217 273 253 272 291 1.47
Natural gas 280 337 269 239 258 -0.39
Bioenergy and Waste 29 46 80 91 81 5.28
Electricity 106 116 123 130 144 1.53
Heat 64 58 50 44 44 -1.79

*Latest available data, please note that compound annual growth rate may not be representative of actual average growth.

**Total energy derived from primary and secondary generation sources. Figures do not reflect potential heat output that may result from electricity co-generation.

-:data not available.

Source(s): United Nations Statistical Division, OECD/IEA and IAEA RDS-1

1.2. THE ELECTRICITY SYSTEM

1.2.1. Electricity system and decision making process

The liberalization of Hungary's electricity market was completed in 2008. Today, the free choice of energy supplier applies to every consumer, although prices in some segments are still regulated within the 'universal service'. The Directive (EU) 2019/944 of the European Parliament and of the Council of 5 June 2019 on common rules for the internal market for electricity and amending Directive 2012/27/EU establish common rules for the generation, transmission, distribution, energy storage and supply of electricity, together with consumer protection provisions, with a view to creating truly integrated competitive, consumer centred, flexible, fair and transparent electricity markets in the European Union.

The installed capacity of domestic power plants on 31 December 2021 was 11 486 MW(e) (preliminary data). The peak load of Hungary's electricity system was 7 361 MW in 2021 (and this was surpassed on 25 January 2022, when the peak load reached 7 396 MW). The peak load in 2021 represents an increase from the 2020 level, which was 7 095 MW. Although the increase in energy efficiency may help reduce the rate of increase of primary energy consumption, it is still expected that overall electricity demand will increase. Taking into account the necessary shutdown of old fossil fuel power plants in the near future, new generation capacities may be required in the coming decade, despite the solar photovoltaic boom currently taking place in Hungary, reaching almost 3 000 MW in total installed capacity as of the end of 2021.

In 2021, the electricity generation mix of the Hungarian electricity system was well balanced, with about 26% generated from gas, 45% from nuclear, 9% from coal and lignite and an increasing ratio of renewables (from 16% to 19%). The electricity production from renewable energy sources is growing in accordance with the EU directive on green electricity. In 2021, renewable based electricity production made up a share of 19% of gross electricity production, and is expected to rise steeply in the next few years owing to the various forms of support for renewable energy sources of electricity.

Hungary's energy supply is around 54% import dependent (based on 2021 data); therefore, its security is a crucial priority of the National Energy Strategy. The safe, successful and profitable operation of the state-owned Paks NPP greatly contributes to meeting this challenge. The obligatory stockpiling of nuclear fuel for two years is also an essential element in ensuring the stability of supply in case of any disturbances in imports.

In Hungary, the only transmission system operator is MAVIR (Magyar Villamosenergia-Ipari Atviteli Rendszeriranyito Zrt.), which operates as an independent member of the state-owned MVM Group (Magyar Villamos Muvek Zàrtköruen muködo RÈszvÈnytàrsasàg: Hungarian Electrical Works Private Limited Company) in accordance with the independent transmission operator model. Thus, being a company independent of any other participants of the energy industry, MAVIR ensures the operation of the whole electricity transmission system in a way that each of its players may deploy their services on an equal basis. In addition, there are six distribution system operator companies in Hungary, all of them according to the strict unbundling rules of the former Third Energy Package of the European Union. Although almost all residential customers are supplied within universal service, intense competition can be observed on the non-household electricity market.

In Hungary, the Government and the national regulatory authority, the Hungarian Energy and Public Utility Regulatory Authority (HEA), shape the legislative environment for electricity. The energy policy belongs to the Government, where currently the Ministry of Innovation and Technology is responsible for the country's energy strategy and the development of policies relating to renewable energy, energy efficiency and decarbonization.

The HEA regulates and supervises the activities of electricity, natural gas, district heating and water public utility companies, leading national competence regarding price regulation of waste management, energy statistics and consumer protection. However, the most important responsibilities of the HEA include the following:

  1. Issuing decrees (determining the network access and network usage fees for both the electricity and gas transmission and distribution systems, determining the conditions and rules for the application of such fees);

  2. Issuing, amending or withdrawing the authorizations required for performing activities regarding electricity, gas, district heating and water public utility;

  3. Approving commercial codes, operational network codes (transmission system operator, distribution system operator), network development plan (transmission system operator), business codes (traders, generators) and market rules of the exchanges;

  4. Monitoring compliance with the obligations of the licensees, the execution of cross-border transmission of electricity and gas, competition in the electricity and gas markets (including the balancing market) in the course of market surveillance activities, and performance of market analysis and regulatory inspections;

  5. Making preliminary proposals for the regulations relating to the pricing mechanisms of universal services;

  6. Resolving complaints lodged against authorized operators (shared competence with the Authority for Consumer Protection).

In addition to classic regulatory tasks mentioned above, the HEA is also responsible for managing applications for different renewable energy source electricity supporting regimes, as well as for the controlling of implementing energy efficiency measures in case of organizations concerned by relevant legislation. The HEA is a legal entity with a separate and independent budget, reporting on an annual basis to the Parliament on its activities. Its president is appointed by the Prime Minister for seven years, which may be extended once for an additional seven years.

1.2.2. Structure of electric power sector

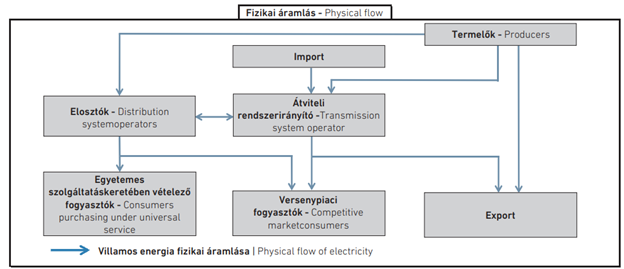

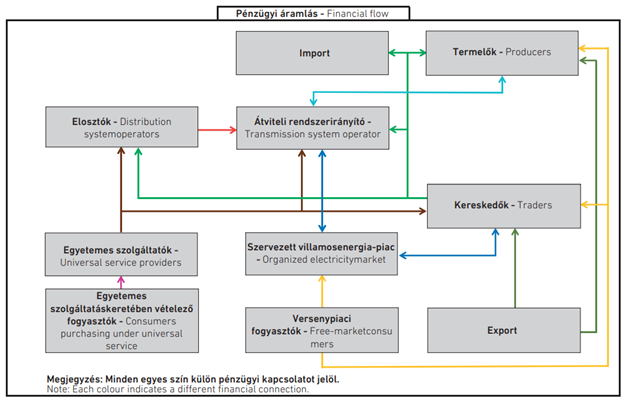

Today, the power industry is restructured and partly privatized. Figure 1 shows the simplified model of Hungary's electricity industry.

FIG. 1. Hungarian electricity industry as of 2022.

1.2.2.1. MVM Group

MVM Group is the third largest company in Hungary and the 13th largest in Central Europe. It is a fully state owned company, is gaining regional dominance, is acting as the largest domestic energy knowledge centre and offers a significant contribution to supply security in Hungary and Central Eastern Europe through its professional competences.

MVM Group's key indicators are the following: active presence in 23 countries, more than 120 subsidiaries, more than 18 000 employees, more than 8 million household and company clients, ~60% share of the country's power generation, indispensable role in Hungary's renewable energy generation, nearly 50% market share in gas supply of industrial consumers and 100% of household sector through universal service providers.

Among others, MVM Group treats the following as priorities: the operation and continual development of the transmission network, the professional provision of natural gas trading and storage services, e-mobility, the development of smart city technologies and the provision of advanced telecommunications solutions for the Government (see Fig. 2).

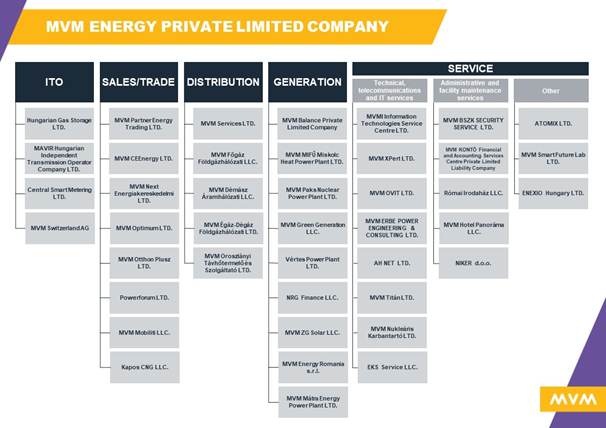

FIG. 2. The structure of the MVM Group.

1.2.2.2. Transmission operator

In Hungary, high voltage electricity is transmitted on a single common transmission line network, which is owned and operated by the MVM Group member MAVIR (www.mavir.hu). This organization operates according to the independent transmission operator model, independent of other economic operators that use the transmission network, and its independence is assured by legislation. In accordance with the relevant statutory regulations, MAVIR, as an organization independent of other participants in the electricity system, is responsible for ensuring a secure energy supply.

1.2.2.3. Electricity distribution

There are six regional distribution companies responsible for operating networks with a voltage of 120 kV and below, as well as supply for customers (see Table 3).

SIX REGIONAL DISTRIBUTION COMPANIES

Company

Web site

E.ON Èszak-dunàntùli àramhàlòzati Zrt.

www.eon.hu/hu/rolunk/vallalatcsoport/eon-eszak-dunantuli-aramhalozati-zrt.html

E.ON DÈl-dunàntùli àramhàlòzati Zrt.

www.eon.hu/hu/rolunk/vallalatcsoport/eon-del-dunantuli-aramhalozati-zrt.html

OPUS TITàSZ àramhàlòzati Zrt.

https://www.opustitasz.hu/

ELMÜ Hàlòzati Kft.

eloszto.elmu.hu/

MVM Èmàsz àramhàlòzati Kft.

eloszto.mvmemaszhalozat.hu/

MVM DÈmàsz àramhàlòzati Kft.

www.mvmhalozat.hu

1.2.3. Main indicators

TABLE 3. ELECTRICITY PRODUCTION

Electricity production (GWh) 2000 2005 2010 2015 2020 Compound
annual growth
rate 2000-2020 (%)
Total 35 191 35 756 37 371 30 360 34 930 -0.04
Coal, Lignate and Peat 9 707 7 146 6 350 5 908 3 826 -4.55
Oil 4 404 455 490 77 45 -20.48
Natural gas 6 602 12 379 11 598 5 108 9 091 1.61
Bioenergy and Waste 120 1 730 2 449 2 302 2 396 16.15
Hydro 178 202 188 234 244 1.59
Nuclear 14 180 13 834 15 761 15 834 16 055 0.62
Wind 0 10 534 693 655 0.00
Solar 0 0 1 141 2 459 0.00
Geothermal 0 0 0 0 16 0.00
Other 0 0 0 63 143 0.00

*Latest available data, please note that compound annual growth rate may not be representative of actual average growth.

**Electricity transmission losses are not deducted.

-:data not available.

Source: United Nations Statistical Division, OECD/IEA and IAEA RDS-1

TABLE 4. ENERGY RELATED RATIOS

Final Energy consumption [PJ] 2000 2005 2010 2015 2020 2021*
Nulcear/total electricity(%) 40.6 37.2 42.1 52.7 48 46.8

*Latest available data.

Source: RDS-1 and RDS-2

-:data not available.

2. NUCLEAR POWER SITUATION

2.1. HISTORICAL DEVELOPMENT AND CURRENT ORGANIZATIONAL STRUCTURE

2.1.1. Overview

Hungary's first reactor was built for research purposes in 1959 at CsillebÈrc, on the outskirts of Budapest. The reactor, of Soviet origin and refurbished by experts in Hungary after 30 years of operation, was again put into operation by the Atomic Energy Research Institute in 1993. The Budapest Research Reactor is a tank type reactor with 10 MW(th) capacity and is operated by the Centre for Energy Research, functioning in the framework of the Eötvös Lorànd Research Network.

The Training Reactor of the Institute of Nuclear Techniques of the Budapest University of Technology and Economics (BME NTI) was put into operation in 1971. Since then, the training reactor has been used mainly for the purposes of education in the nuclear field. It is a pool type reactor with 100 kW(th) capacity.

The Paks NPP has four WWER-440/213 second generation units. Owing to successful upgrades in the past, the nominal electrical power outputs of the units are 508.6 MW, 506 MW, 506 MW and 506 MW, respectively. The plant is located 5 km south of the town Paks. Since 1980, the four units have played a key role in Hungary's power system.

Hungary's national policy concerning the application of atomic energy is regulated by law. The basic purposes of the Act on Atomic Energy are protecting the health and safety of the population and protecting the environment. The provisions of the act state that the use of atomic energy is allowed only in a manner stipulated by law and under the permanent control of the competent authority. Regardless of what aspect of atomic energy is being considered, safety is a prevailing priority.

2.1.2. Current organizational structure

2.1.2.1. Governmental organizations in the nuclear field

Following the Hungarian parliamentary elections of 2018, the newly established Ministry for Innovation and Technology (www.kormany.hu/en/ministry-for-innovation-and-technology) was made responsible for energy affairs and climate policy development. In his role, the Minister of Innovation and Technology exercised legal supervision over the HAEA until the end of 2021. On 1 January 2022, an amendment to the Act on Atomic Energy entered into force, whereby the HAEA became an organ of special status. The President of the HAEA has the competence to issue regulations and reports directly to the Parliament on the activities of the regulatory body. HAEA defines its own organizational structure and determines the number of its staff considering its available budget.

After the elections of 2018, a Minister without Portfolio (functionally separate and independent of other ministries) is responsible for the management of national assets (i.e. exercising the ownership rights over the MVM Paks NPP Ltd). In addition, a Minister without Portfolio is responsible for the planning, construction and commissioning of the two new units at the Paks site.

The Ministry of Human Capacities undertakes the tasks of the authority regarding radiation protection as it pertains to medical irradiation.

The Ministry of Agriculture is responsible for establishing air and water quality standards, and limits on radioactive releases from nuclear facilities, as well as controlling emissions at the facilities in relation to the environment.

(Please note that following the 2022 parliamentary elections, at the time of the update of the CNPP, the new administration has not yet taken office.).

2.1.2.2. Regulatory body

As of 1 January 2022, the HAEA is an organ of special status with responsibilities in the field of the peaceful applications of atomic energy. The HAEA has the competence to perform regulatory tasks and to issue regulations in the nuclear field, while also having organizational and financial independence. Establishing regulatory duties in connection with the safety of the peaceful application of nuclear energy, particularly the safety of nuclear facilities under normal and accident conditions and safety in nuclear emergencies, is a basic task of the HAEA. The President of the HAEA is appointed by the Prime Minister for a nine-year period. The HAEA resolutions can only be appealed or amended in court.

2.1.2.3. Licensees

MVM Paks NPP Ltd (https://atomeromu.mvm.hu/) operates four WWER-440/213 type power reactors.

The goal of Paks II Ltd (www.paks2.hu) is to perform tasks involving the preparation, establishment, commissioning and operation of new NPP units at a high professional standard.

The Public Limited Company for Radioactive Waste Management (PURAM, www.rhk.hu) operates the SFISF at Paks; the RWTDF at PUspokszilay, managing low and intermediate level waste (LILW) generated by medical, industrial and research applications; and the NRWR in Bàtaapàti, a final disposal facility for LILW generated at the Paks NPP. PURAM is investigating the Boda Claystone Formation in West Mecsek to select a site for high level and long lived radioactive waste.

2.1.2.4. Research institutions

The Centre for Energy Research functions under the framework of the Eötvös Lorànd Research Network (www.ek-cer.hu).

The Centre operates the 10 MW(th) Budapest Research Reactor, which is active in several fields of nuclear technology, such as reactor physics, thermohydraulics, health physics, simulator techniques and reactor chemistry. It performs a wide variety of research related to the use of radioactive materials and nuclear techniques, among them an R&D development programme for nuclear safeguards. It provides expert support and laboratory equipment for the HAEA. The forensic nuclear laboratory is the result of unique cooperation between the IAEA and a research institute, providing the HAEA with useful information on nuclear security. Research proposals of the experts of the centre support the HAEA in different fields.

In December 2016, the IAEA appointed the Centre for Energy Research as the Collaborating Centre of the IAEA for Nuclear Forensics in Hungary.

The Institute of Nuclear Research (ATOMKI, Debrecen) operates a 20 MeV cyclotron and a 5 MeV Van de Graaff accelerator and is active in several fields of nuclear physics and nuclear techniques (www.atomki.hu). The ATOMKI functions under the framework of the Eötvös Lorànd Research Network.

The National Public Health Centre (NPHC) was established on 1 October 2018, merging several national institutions working on various fields of public health. The Department of Radiobiology and Radiohygiene (DRR) of the NPHC performs a wide spectrum of research, including on the biological and therapeutic effects of radiation. The Accredited Testing Laboratory of DRR can perform basic radioactivity measurements of food and feed, as well as measurements in air, water and soil. DRR is responsible for the quality tests of radiating medical equipment and for the national radon action plan. DRR plays an important role in the development of the national nuclear emergency response plans and in aiding the diagnosis and treatment of radiation injuries and operates the National Radiohygiene Emergency Service, which operates on 24 hour duty and responds to calls regarding radiation situations.

The Nuclear Safety Research Institute (NUBIKI) carries out safety analysis and risk assessment of nuclear power plants, including level 1 and 2 probabilistic safety assessment and severe accident analysis (www.nubiki.hu).

The BME NTI operates a training reactor; teaches nuclear technology for engineers, physicists, chemists and environmentalists; and performs research on different nuclear related topics (www.reak.bme.hu).

The Power Engineering and Contractor Co., Pöyry Eroterv Co. (before 2010: ETV-EROTERV Co., Budapest) works in the fields of design, construction, commissioning and operating management of nuclear facilities. Its activities include waste management (treatment, storage and disposal) (www.poyry.hu).

The Department of Nuclear Medicine of the University of Debrecen (www.nmc.dote.hu) operates a GE PETtrace cyclotron and a radiochemistry centre, which develop and produce positron labelled radiopharmaceuticals for medical and research purposes.

The Institute of Radiochemistry and Radioecology at the University of Pannonia has a wide range of topics in research and education in two main fields: radiochemistry and nuclear technology, as well as radioecology and radiation protection (https://mk.uni-pannon.hu/index.php/english.

2.2. NUCLEAR POWER PLANTS: OVERVIEW

2.2.1. Status and performance of nuclear power plants

TABLE 5. STATUS AND PERFORMANCE OF NUCLEAR POWER PLANTS

Reactor Unit Type Net
Capacity
[MW(e)]
Status Operator Reactor
Supplier
Construction
Date
First
Criticality
Date
First Grid
Date
Commercial
Date
Shutdown
Date
UCF
for
2021
PAKS-1 PWR 479 Operational PAKS Zrt AEE 01/08/1974 14/12/1982 28/12/1982 10/08/1983 89.4
PAKS-2 PWR 479 Operational PAKS Zrt AEE 01/08/1974 26/08/1984 06/09/1984 14/11/1984 80.7
PAKS-3 PWR 479 Operational PAKS Zrt AEE 01/10/1979 15/09/1986 28/09/1986 01/12/1986 99.7
PAKS-4 PWR 479 Operational PAKS Zrt AEE 01/10/1979 09/08/1987 16/08/1987 01/11/1987 91.1
Data source: IAEA - Power Reactor Information System (PRIS).
Note: Table is completely generated from PRIS data to reflect the latest available information and may be more up to date than the text of the report.

The Paks NPP generated 15989,736 GW·h of electric energy in 2021, which represents 46. 8% of the gross domestic electricity production of Hungary. This amount was generated by Units 1-4, respectively, as follows: 3976,627 GW·h; 3577,378 GW·h; 4440,255 GW·h; 3995,475 GW·h. The amount of electricity that has been generated by the Paks NPP since the date of the first connection of Unit 1 to the grid was higher than 525,667 TW·h at the end of 2021.

2.2.2. Plant upgrading, plant life management and licence renewals

The Paks NPP consists of four WWER-440/213 type reactor units, originally designed to produce 1375 MW(th) and 440 MW(e) each. Earlier upgrades of the secondary circuit and turbine increased the electrical output to about 470 MW(e) in each unit, with no change to thermal capacity. An upgrade of the primary side was completed that increased the nominal power by 8% to 1485 MW(th), resulting in about 500 MW(e) of power generation by each unit. By the end of 2009, the uprating process was completed successfully on all four units, and 2010 was the first year the units operated at the increased power level. A recent upgrade of the turbines enables the units to reach over 500 MW(e); owing to turbine reconstruction, with stage installations added in the high pressure cylinders of the turbines on all units, the nominal outputs of the units are now (gross capacity) 508.6 MW, 506 MW, 506 MW and 506 MW, respectively.

At the end of 2008, the Paks NPP submitted a lifetime extension programme to the HAEA to justify the establishment of the operating conditions and safe operation beyond the design lifetime. The HAEA evaluated the programme and ordered the licensee to implement the programme with certain conditions. The HAEA regularly reviews and evaluates the progress reports of the lifetime extension programme. The HAEA granted an operating licence for all units for an additional 20 years, subject to the periodic safety assessment of the units. The validity of the new operation licences was requested to be the same as licences during lifetime extension, that is: Unit 1 until 31 December 2032; Unit 2 until 31 December 2034; Unit 3 until 31 December 2036; and Unit 4 until 31 December 2037.

The HAEA issued a licence to introduce a 15 month operation interval at Units 1-4 of the Paks NPP, and as a preliminary measure, to implement a new type of fuel assembly with a mean enrichment of 4.7%. The modification of the licence regarding the new 15 month operating cycle was issued by the HAEA on 14 October 2019.

In December 2020, Paks Nuclear Power Plant introduced 18 Lead Test Assemblies of a new water-uranium ratio optimized so-called SLIM fuel at Unit 3, 35th cycle. This new fuel type has thinner cladding and solid pellets (except for rods containing burnable absorber, which still have a central hole), and the spacer grids are equipped with mixing vanes to enhance the mixing of the coolant. This new concept allows for more economical fuel usage as the lack of the central hole increases the weight of uranium in the fuel rod and the thinner cladding results in bigger utilization of fissile material, with less fresh fuel necessary per fuel cycle and a reduced number of spent fuel assemblies. The HAEA has issued a license for the introduction of 18 Lead Test Assemblies in 2020.

2.2.3. Permanent shutdown and decommissioning process

2.3. FUTURE DEVELOPMENT OF NUCLEAR POWER SECTOR

2.3.1. Nuclear power development strategy

The construction of new units at the Paks site was proposed to meet future electricity demand. The recently adopted National Energy Strategy and National Energy and Climate Plan through 2030, with an outlook up to 2040, foresee the long term preservation of nuclear power in the energy mix.

Under Hungary's Act on Atomic Energy, the Government shall obtain a decision-in-principle from the Parliament to start any preparatory activity that could lead to the construction of a new nuclear facility. On 30 March 2009, members of the Hungarian Parliament gave their decision in principle, with more than 90% of the votes in support of it.

After this, preparation for the construction of the new units commenced. The activities included preparations for obtaining environmental and site licences. A survey was also initiated to determine possible suppliers for the construction of the new units and demand for the necessary labour.

In order to prepare the planned new units, the MVM Group established its new project company, MVM Paks II Nuclear Power Plant Development Ltd (MVM Paks II Ltd) in 2012. Since November 2014, owing to a change in ownership, the project company no longer belongs to MVM Group and is named Paks II Ltd. It came under direct State control when the Prime Minister's office obtained the owner's rights in 2014. Since 3 May 2017, the project company's ownership rights and obligations have been exercised by the minister without portfolio responsible for the planning, construction and commissioning of the two new units at the Paks NPP.

2.3.1.1. Update of the Nuclear Safety Regulation

For the licensing of the new units, the HAEA has started reviewing four important areas: regulatory requirements, the licensing framework, technological and safety characteristics of new units, and the international framework. The most important goal of the HAEA was to adopt the strictest requirements set by the latest findings of science and technology. As part of the review process, the representatives of the nuclear industry, the HAEA and the Hungarian National Standard Committee agreed on the promulgation of a series of international standards specific to NPPs to cover the necessary technical fields for which Hungarian National Standards were not available. The first series of standards covering the principles of instrumentation, control room and emergency control room design, display of safety parameters, detection of leakages and loose parts in the primary circuit, neutron flux monitoring, radiation monitoring and alarming were published as Hungarian National Standards in January 2011.

According to the Act on Atomic Energy, the safety requirements for use of nuclear energy are to be regularly reviewed and modernized, taking into account the achievements of ongoing scientific and international experience. As a result of the review, Government Decree No. 118 of 2011 (VII. 11) on nuclear safety requirements of the nuclear facilities and on the related legal activities was issued and entered into force on 10 August 2011. The reviewed Nuclear Safety Code was published in annexes to the Government decree.

The requirements related to the new nuclear facilities were elaborated (Vol. 3/A of the Nuclear Safety Code) and the extended set of regulations entered into force on 1 January 2015.

Based on the nuclear safety codes in the field of nuclear safety, it is mandatory to provide the opinion of an independent technical expert with the licence applications. The registration and evaluation processes for these technical experts are regulated in the Act on Atomic Energy (Act No. 116 of 1996) and its implementation decree [Government Decree No. 247 of 2011 (XI.25.)].

Comprehensive modification of the Nuclear Safety Code was undertaken in the second half of 2014, covering the results of the revision of the Western European Nuclear Regulators Association (WENRA) requirements and the results of other countries' NPP construction experience, including relevant Finnish and UK regulations and also Hungary's licensing experience.

In addition to the continual development of IAEA recommendations and WENRA reference levels, the Hungarian regulations are reviewed and revised more frequently than the five year review period stipulated by law.

The latest five year review of the Nuclear Safety Code was carried out in 2017-2018. New rules were added by Government Decree No. 70 of 2018 (IV. 9.), meaning a comprehensive amendment of Government Decree No. 118 of 2011 (VII. 11).

Since 1 January 2017, Article 12, Section 7 of the Act on Atomic Energy allows the simultaneous licensing and permit procedures for structures and construction activities directly and indirectly implied in the functioning of nuclear installations and of radioactive waste repositories.

In 2017-2018, regulatory harmonization was also undertaken. On one hand, Government Decree No. 457 of 2017 (XII. 28) made the appropriate changes to fit in the introduced general administrative regime. On the other hand, Government Decree No. 28 of 2018 (II. 28) ensures compliance with Council Directive 2013/59/Euratom of 5 December 2013 laying down basic safety standards for protection against the dangers arising from exposure to ionizing radiation, and repealing Directives 89/618/Euratom, 90/641/Euratom, 96/29/Euratom, 97/43/Euratom and 2003/122/Euratom.

The HAEA regularly evaluates the safety performance of operators of nuclear facilities. The main sources of data for the assessment are regular reports and event reports of the licensees, the protocols of regulatory inspections including regular and comprehensive inspections focusing on specific areas, and reactive inspections.

On 24 October 2018, the NPP modified its technical specification in a document approved by the HAEA and started to use the Operational Limits and Conditions (OLC). Since then, there have not been any violations of the OLC.

Over the past years, the Nuclear Safety Regulation has undergone several changes that concern the construction of the new NPP units. The Act on Atomic Energy creates the possibility that in the case of certain structures, construction activities, as well as the equipment with a long production time, the relevant construction permit procedure carried out by the HAEA may be carried out simultaneously with the construction licensing procedure of the NPP. Government Decree 118/2011 lays down detailed rules for this process.

In connection with the requirements for the new units, the definitions regarding the involvement of independent experts and the accreditation of independent expert organizations (that is authorised by legislation and is independent from the licensee) have been clarified, ensuring the contribution of an objective party in the process that is independent from undue influence.

2.3.1.2. Establishment of the contractual and legal framework of the new build project

In January 2014, the Government of Hungary signed a bilateral agreement (intergovernmental agreement, IGA) with the Russian Federation on cooperation in the peaceful use of nuclear energy. The agreement was promulgated in Act No. 2 of 2014. The agreement covers, among other topics, the cooperation necessary for maintaining the capacity of the Paks NPP, which means the planning and construction of two new nuclear units at the Paks site. In accordance with the IGA, on 28 March 2014, the Government of Hungary and the Government of the Russian Federation signed an agreement on the provision of a state credit (financial IGA, FIGA) of maximum €10 billion to Hungary to finance 80% of the project (for funding details, see Section 2.3.3). This agreement was promulgated in Act No. 24 of 2014.

Also in 2014, the Hungarian nuclear licensing regulatory framework was revised, modernized and made fit for instant licensing procedures. As a result, Act No. 7 of 2015 (Project Act) was adopted by the Parliament and the licensing and investment environment of the project was successfully created. The new regulation included an increase of the staff and the remuneration of the HAEA as well as an extension of the timeframe available for the HAEA to evaluate the construction licensing documentation from 6 months to 18 + 3 or 12 + 12 + 3 months.

A Government commissioner was also assigned by Government Resolution No. 1358 of 2014 (VI. 30) to supervise and support the project from 1 July 2014. Starting in November 2014, MVM Paks II Ltd was under direct state ownership and was controlled by the minister leading the Prime Minister's office. Since 3 May 2017, MVM Paks II Ltd's ownership rights and obligations have been exercised by the minister without portfolio responsible for the design, construction and installation of the two new NPP units of Paks.

After negotiations in the second half of 2014, MVM Paks II Ltd and the Russian Joint Stock Company Nizhny Novgorod Engineering Company Atomenergoproekt (JSC-NIAEP) signed three implementation agreements on 9 December 2014. These agreements include: (i) the engineering, procurement and construction contract (EPC) for two WWER-1200 type new nuclear units; (ii) an operation and maintenance support contract; and (iii) a nuclear fuel supply contract. In April 2015, the Euratom Supply Agency co-signed the nuclear fuel supply contract. On 1 January 2015, the implementation of the EPC began. With the IGAs and the implementation agreements, the project's fundamental elements - its contractual framework - were established.

From November 2015 to April 2017, more investigations were conducted by the European Commission. During this period, the implementation of the EPC was suspended by the European Commission. After having closed the last investigation regarding State aid for the Paks II project, the standstill ended.

Given the fact that a new administrative regime came into force on 1 January 2018 (Act No. 150 of 2016 on General Administrative Regulations), it was necessary to adapt the Act on Atomic Energy to the aforesaid law. In light of the above, Act No. 50 of 2017 has made the necessary amendments to the Act on Atomic Energy.

In accordance with the provisions in force, the procedural timeframe available for the HAEA to evaluate the construction licensing documentation is 12 months, which may be extended by three months in justified cases.

Act No. 45 of 2018 on the modification of the Act on Atomic Energy are related to the independent technical experts and expert organizations.

The purpose of Act No. 39 of 2019 on the Amendment to the Act on Atomic Energy was to comply with Act No. 150 of 2016 on General Public Administration Procedures and to establish procedural issues not covered it.

2.3.1.3. Ongoing licensing and pre-construction work

The preparations for construction of the new units are coordinated by Paks II Ltd and the minister without portfolio responsible for the design, construction and installation of the two new NPP units of Paks.

On 27 February 2018, Paks II Ltd officially handed over the work area to the main contractor, ASE Engineering Company belonging to the Rosatom Group, for the construction of the first construction support base facilities. The construction work on the first construction support base facilities started with the administrative and amenity buildings on 20 June 2019.

One of the tasks of Paks II Ltd is to provide electricity for the contractor for construction-installation works. In order to fulfil the task, a 22/11 kV transformer station is needed for the construction support base area. Work on this project started in early 2018 and was completed in the first half of 2019. Construction of other utility connection points also started.

In 2020 two office buildings, which will be occupied in 2022, and a kitchen diner for 100 people were constructed.

Also in 2020. the construction of a third office building, the Power Plant Investment Centre, started in the immediate vicinity of the site. This new office building was completed by summer 2021 and the engineers of the project company moved in on 13 September 2021.

In 2020, 21 buildings and edifices of the construction and erection base received the construction licence from the HAEA.

The work is continuous on the construction and erection base, 18 buildings or facilities are being implemented across five complexes. A concrete plant, a complex of steel and rebar assembly plants, several administrative and service buildings, a complex of anti-corrosion works and a contractor warehouse are currently under construction.

In accordance with the terms of the site licence, Paks II Ltd keeps the HAEA informed regularly (monthly) about the planning activities and the works related to the facility.

On 30 June 2020, Paks II Ltd submitted the construction licence application to the HAEA. The official administrative deadline for the construction licence procedure is 12 months (which was extended by the HAEA by 3 months). Following the 15 months of review, HAEA ordered Paks II to submit more documents and clarifications.

Paks II Ltd submitted its application for a physical protection licence to the HAEA on 24 September 2020, which contains the Physical Protection Plan of the future facility. This license was issued by the authority on 25 August 2021.

Paks II Ltd received the so-called electricity implementation licence from the HEA on 19 November 2020. The HEA licence is of key importance in connection with the start of the construction of the new units as electricity generating units and will increase the number of major licences such as the environmental licence and the site licence. With the implementation licence of the HAEA and the HEA, the project can obtain the additional licences on the basis of which the actual construction, production, procurement and installation works of the new units can begin.

On 5 October 2021 the National Directorate General for Disaster Management, Ministry of the Interior issued the disaster management licence for the project. On 16 November 2021 Paks II Ltd submitted the license application for the construction of the reactor pressure vessels to the Hungarian Atomic Energy Authority.

On 30 December 2021 Paks II. Ltd. submitted the construction license application for the reactor building of Unit 5 to the Hungarian Atomic Energy Authority.

TABLE 7. PLANNED NUCLEAR POWER PLANTS

Station/project name Type Capacity (MW(e)) Expected construction start year Expected commercial year
Paks 5 PWR 1185 n.a. n.a.
Paks 6 PWR 1185 n.a. n.a.

Note: n.a. - not applicable; VVER (WWER) - water cooled, water moderated power reactor.

2.3.2. Project management

The delivery of the new nuclear power plant units will be a turnkey project. The preparations for construction of the new units are being coordinated by Paks II Ltd and the minister without portfolio responsible for the planning, construction and commissioning of the two new blocks at the Paks NPP.

2.3.3. Project funding

According to the FIGA, the Russian Federation grants Hungary a maximum of €10 billion credit, which will finance 80% of the contract price of the EPC. Hungary will finance 20% of the contract price. According to the recent amendment of FIGA in June 2021, the target date was changed - the repayment must start in 2031 at the latest, following the commissioning of the two new nuclear power plant units, thus, the repayment can be produced by the commercially operating new nuclear power plant.

Conditions of the credit line available to the Hungarian State as set out in the FIGA are as follows:

  1. Credit amount: 80% of the agreed amount of the EPC, maximum €10 billion.

  2. Repayment period: 16 years:

    • in the first 2 years of repayment: 10% of the whole amount, in 4 equal installments;

    • in the second 7 years of repayment: 40% of the whole amount, in 14 equal installments;

    • in the last 7 years of repayment: 50% of the whole amount, in 14 equal installments.

  3. Interest rate:

    • until 15 March 2026: 3.95%;

    • until 15 September 2032: 4.50%;

    • until 15 September 2039: 4.80%;

    • until the last day of the loan repayment: 4.95%.

  4. Commitment fee: 0.25% of the undisbursed amount from the preliminarily agreed annual credit line.

2.3.4. Electricity grid development

A new high voltage substation and a new double circuit overhead line of 400 kV are planned to be constructed. In order to provide increased reliability, the new substation and the substation of the existing nuclear power plant will be connected by means of two coupling lines of 400 kV.

2.3.5. Sites

The planned installation site of the new Paks II NPP units is situated in the area neighbouring the Paks NPP site. The site is located in Tolna County, about 118 km south of Budapest. The construction area lies 5 km south of the centre of Paks, 1 km west of the River Danube and 1.5 km east of Main Road No. 6.

2.4. ORGANIZATIONS INVOLVED IN THE CONSTRUCTION OF NPPs

The primary organizations in the construction of nuclear power plants in Hungary are Paks II Ltd (www.paks2.hu/en/web/paks-2-en/) and the Atomstroyexport Engineering Company (www.atomstroyexport.ru/wps/wcm/connect/ase/eng).

2.5. ORGANIZATIONS INVOLVED IN THE OPERATION OF NPPs

MVM Paks Nuclear Power Plant Ltd is a state-owned company. MVM Hungarian Electricity holds 100% of the shares (with authority granted by the State). The operator is the MVM Paks Nuclear Power Plant. The technical support organizations (TSOs) are listed in Section 2.1.2 (current organizational chart).

2.6. ORGANIZATIONS INVOLVED IN THE DECOMMISSIONING OF NPPs

For decommissioning, a multistep licensing procedure is established, in which the first step is to obtain the authorities' consent to terminate operation. A further requirement is a valid environmental protection licence based on an environmental impact assessment and public hearings. As in all phases of the life cycle of a facility, radiation protection authorities are involved in these licensing procedures, and they license the appropriate radiation protection programme and radiation protection organization separately.

During the dismantling, decontamination and other steps, an ongoing task of the authority is the control of the radiation situation within the facility and around it, including the monitoring of personal doses and discharges, as well as of the radiation in the environment. Emergency plans must be updated with new or likely scenarios and any necessary organizational changes must be adjusted accordingly.

PURAM is a 100% state-owned, non-profit enterprise, established by the director general of the HAEA on behalf of the Government. Its tasks, as set out by the Act on Atomic Energy, include the final disposal of radioactive waste, the interim storage of spent fuel, the closure of the nuclear fuel cycle and the decommissioning of nuclear installations. The ownership of PURAM (previously exercised by the HAEA) was transferred to Hungarian National Asset Management Inc. at the end of 2013, but the regulatory tasks remained among the responsibilities of the HAEA.

2.7. FUEL CYCLE, INCLUDING WASTE MANAGEMENT

2.7.1. Fuel cycle

Hungary has 20 000 t of exploitable uranium resources and 10 000 t of additional reserves. There are three areas in Hungary where uranium occurrences are known, but only one region in the Mecsek Mountains has been exploited. Hungary mined uranium ore, which was processed into yellowcake at Mecsek and then shipped to the Russian Federation. Fuel cycle services were guaranteed by the former Union of Soviet Socialist Republics (USSR) when Hungary purchased Soviet reactors, including the fabrication and shipping of the fabricated fuel assemblies to Hungary, and the return of the spent fuel to the former USSR. Hungary does not have other fuel cycle capabilities such as fuel conversion, enrichment or fabrication capacities.

There are no reprocessing capabilities in Hungary, and no plans to develop any.

Through advances in technology and innovation new fuel assemblies with improved parameters have been introduced at the Paks NPP over its operation. The enrichment of the new fuel has increased, and it contains burnable poison (gadolinium isotope). The increased enrichment enhances the economic efficiency of the fuel cycles, while the application of the burnable poison compensates for the potential negative effects of the increased enrichment on the safety features of the reactors and the transport and storage devices, with the change matching a worldwide trend. In 2010, test operation of 18 assemblies was completed following licensing in 2009. The preliminary use of the test assemblies was necessary for the validation of the design computer codes. When the test programme was finished successfully, the HAEA issued a licence for the general use of the new fuel. On this basis, the first batch of the new fuel assemblies was loaded at Unit 4 in 2010. The results of a special inspection programme showed that the behaviour of the fuel assemblies is in harmony with the preliminary estimates and design requirements. The transition to the new fuel has been finished, and its aim was to make possible the power uprate of the units. Implementing similar processes, improved fuel was introduced to extend refuelling outage intervals from 12 to 15 months.

To improve the efficiency of fuel utilization, fuel assemblies containing the so-called SLIM fuel pins have been licensed and are gradually being installed in the reactors. This new fuel type has thinner cladding and pellets without central holes (except for rods containing burnable absorber, which still have a central hole), and the spacer grids are equipped with mixing vanes to enhance the mixing of the coolant. This new concept allows for more economical fuel usage as the lack of the central hole increases the amount of uranium in the fuel rod and the thinner cladding results in bigger utilization of fissile materials. Therefore, less fresh fuel will be necessary per fuel cycle and thus the number of spent fuel assemblies will be reduced.

The licensing of the SLIM fuel will proceed in two stages. For each introduction of a new fuel type in the Paks NPP, a test programme was used during which a small number of lead test assemblies were placed in one of the reactors. This is also how SLIM fuel is introduced. The MVM Paks NPP has requested a licence for the use of 18 SLIM fuel assemblies in the 35th fuel cycle of Unit 3 in December 2020. The HAEA issued the licence under resolution number HA7191.

The Paks NPP evaluates the experiences from the test programme. In case of a positive operating experience, the second stage of licensing can take place, during which the Paks NPP submits a licence application for the general use of SLIM fuel assemblies. This licence application is expected to be submitted (by Paks NPP to the HAEA) in 2022, after the successful completion of the test programme.

2.7.2. National Policy and National Programme on the Management of Spent Fuel and Radioactive Waste

The basis for creating the National Programme was Parliamentary Resolution No. 21 of 2015 (V. 4) on the adoption of the National Policy on the Management of Spent Fuel and Radioactive Waste in line with the provisions of Council Directive 2011/70/Euratom of 19 July 2011, establishing a community framework for the responsible and safe management of spent fuel and radioactive waste. The Act on Atomic Energy stipulates that the National Policy must be reviewed every five years. The first revision successfully closed at the end of 2020. During the revision, the National Policy was amended to reflect certain minor changes in competencies, the new schedule for the operation of the facilities and to clarify the wording for a better understanding and to create legal consistency.

The National Policy defines the basic principles of the management of all radioactive waste and spent fuel produced in Hungary upon which the national programme was developed and adopted by the Government in 2016.

An important feature of Hungary's National Programme is that the decision maker has not yet found it necessary to make a final decision on the back end of the fuel cycle. Although spent fuel has never been reprocessed in Hungary, the option of future reprocessing (only abroad) is worth reserving.

Nevertheless, it is clear that a domestic deep geological repository is necessary for Hungary, regardless of any decision on the back end of the nuclear fuel cycle. In addition to the reprocessing of spent fuel, operation and decommissioning activities will also inevitably lead to some amount of high level waste.

Being aware of this, the national policy requires a flexible (reversible) yet active approach: the so called 'DO and SEE' policy, instead of allowing delay in real actions (for instance, until the final political decision on the back end is known), a real and ongoing research programme for a deep geological repository is required.

While a final decision on reprocessing (only abroad) is not yet available, research and other planning activities for implementing the National Programme should be based on a reference scenario, which is currently the direct disposal of spent fuel in a domestic deep geological repository, together with other high level waste arising from operation and decommissioning of Paks NPP.

Naturally, the flexible nature of the 'DO and SEE' policy cannot be sustained forever. Eventually, when research and repository development activities require that the waste packages be characterized, it will become necessary to make a clear and final decision on the back end of the nuclear fuel cycle.

2.7.3. Spent fuel

According to the Hungarian-Soviet Intergovernmental Agreement on Cooperation in the Construction of the Paks NPP, signed on 28 December 1966, and the Protocol signed on 1 April 1994 attached to this agreement, the former USSR and the Russian Federation undertook to accept spent fuel assemblies from the Paks NPP in such a manner that the radioactive waste and other by-products arising from the reprocessing of such fuel would not be returned to Hungary. Until 1992, the return of the spent fuel assemblies was conducted without problems, under conditions which were very favourable for Hungary, but which nevertheless deviated from normal international practice. In the interest of ensuring undisturbed operation of the NPP, it became necessary to find an interim solution (50 years) for the storage of spent fuel assemblies.

The SFISF (designed by GEC Alsthom UK) at the Paks site is a modular vault dry storage type spent fuel storage facility which has been receiving irradiated fuel assemblies from the Paks NPP since 1997. The increase of storage capacity is in line with the demands of the Paks NPP. The 33 planned vaults are assumed to be capable of storing all spent fuel until the end of the extended service life of the plant. At present, 24 vaults are ready, allowing for storage of 11 416 spent fuel assemblies. Beginning with vault number 17, a square arrangement is applied for the storage tubes instead of the triangular arrangement that is used in vaults 1-16; consequently, 527 spent fuel assemblies can be stored instead of the original 450.

According to a recently elaborated concept, it is possible to further increase the capacity per vault. By the new storage concepts licensed for vaults 25-33 in 2017, a single vault will be able to store 703 spent fuel assemblies in the future. The construction work for vaults 25-28 was started in 2020 and will be finished in 2024. When the storage facility reaches its maximum planned capacity, it will be able to store a total of 17 743 fuel assemblies in the 33 vaults. At the end of 2021, 10207 fuel assemblies were stored in the SFISF.

2.7.4. Waste management(1)

The basic regulation in force at present, the Act on Atomic Energy, expresses Hungary's national policy in the application of atomic energy. Among other aspects, it regulates the management of radioactive waste and authorizes the Government and the ministers responsible to issue government decrees specifying the most important requirements in this field. The Parliament approved the Act on Atomic Energy in December 1996; the Act entered into force on 1 June 1997. In accordance with this Act, from July 2014, the HAEA took over the responsibility of regulatory oversight of the repositories.

The Act on Atomic Energy states that radioactive waste management shall not impose any undue burden on future generations. To satisfy this requirement, the long term costs of waste disposal and of decommissioning the NPP shall be paid by the generations that enjoy the benefits of nuclear energy production and applications of isotopes. Accordingly, by the Act and its executive orders, a Central Nuclear Financial Fund was established on 1 January 1998 to finance radioactive waste disposal, interim storage of spent fuel, the closure of the nuclear fuel cycle as well as the decommissioning of nuclear facilities. The Government authorized the director general of the HAEA to establish the Public Agency for Radioactive Waste Management; this agency has been in operation since 2 June 1998. In line with the corporate forms used in the European Union, the Public Agency for Radioactive Waste Management was transformed on 7 January 2008 into PURAM.

On the basis of the Act on Atomic Energy, PURAM is to design and carry out radioactive waste management in such a way that it is to be safe during the whole duration of the activity and it does not affect human health and the environment abroad to a greater extent than the accepted value within the country.

In the field of radioactive waste management, the following projects are under way.

2.7.4.1. Disposal of high level and long lived radioactive waste

In 1995, a programme was launched for solving the problem of the disposal of high level and long lived radioactive waste. Although there is no final decision yet on the closure of the nuclear fuel cycle, a domestic deep geological repository must be built in any case for other high level waste, including decommissioning waste. The programme focuses on investigations in the area of the Boda Claystone Formation in West Mecsek. Currently, surface based investigations are taking place, including trenching, drilling boreholes and geological and geomorphological mapping. An underground research laboratory is planned to operate from 2038 to 2054, and the repository will operate from 2064.

PURAM submitted an application to the HAEA for the site survey framework programme licence of a research project for investigating the possible site for the Deep Geological Repository (DGR) of high level and long lived radioactive waste. The licence was issued on 9 July 2019 to PURAM and is valid until 2032. The licence is necessary for submitting applications for site survey licences that are required for a number of different research activities. The research aims to qualify the Boda Claystone Formation as a host for the DGR. The research activities of PURAM are carried out according to the site survey framework programme licence: installing and operation of monitoring and sampling systems and preparation for future research activities.

2.7.4.2. Disposal of low and intermediate level radioactive waste from the Paks NPP: National Radioactive Waste Repository in Bàtaapàti

For the disposal of low and intermediate level waste (LILW) from the Paks NPP - following a countrywide screening and to bolster public acceptance - explorations were carried out in the vicinity of Bàtaapàti (Tolna County, about 65 km southwest of Paks). Reflecting the results of extensive research work, the Hungarian Geological Survey declared the site geologically suitable for housing an LILW geological repository. In November 2005, after a decade spent on siting investigations, the Hungarian Parliament gave its preliminary approval in principle for the construction of the repository by the Resolution of the Parliament No. 85 of 2005 (XI. 23). It is a formal requirement in accordance with the Act on Atomic Energy. Prior to the vote in the Parliament, a local referendum was held, and nearly 91% of the voters (voting percentage 75%) agreed that an LILW repository should be established in Bàtaapàti.

In addition to the ongoing underground research activities, both the licensing procedure and the preparation for construction started in 2006. The competent authority issued the environmental licence in 2007. By October 2008, the surface buildings of the NRWR were completed. Later, the authority granted an operating licence that was valid for the surface part of the facility. The operating licence allows the buffer storage of 3000 drums (with a capacity of 200 litres each) containing low and intermediate level solid radioactive waste from the Paks NPP. The first transports of waste were delivered to the facility at the end of 2008. The first chamber of the repository was put into operation in 2012. The second disposal chamber received an operating licence in 2017. The third and fourth chambers were excavated in 2015. The construction of the third chamber (I-K3) and the integration of its systems for operation started in July 2019 and it is still in process. The capacity of the NRWR will meet the demand of the Paks NPP, and the underground space will be extended to make it sufficient for the entire lifetime of the Paks NPP.

2.7.4.3. Radioactive Waste Treatment and Disposal Facility in PUspokszilay

The RWTDF was built for the disposal of institutional radioactive waste. The low level, solid waste from the Paks NPP was transported to the repository in PUspokszilay only as a provisional solution. At the same time, the capacity of the facility was built for the disposal of institutional radioactive waste. The total capacity of the repository is now 5040m 3. The operating licence for the facility was renewed by the HAEA in 2017 for 50 years.

At the same time, the results of the safety assessments unambiguously indicated that certain spent radiation sources may pose a risk in the distant future, after the closure of the repository, in the event of inadvertent human intrusion. Therefore, with the aim of enhancing the long term safety of the repository, a multi-year programme was launched in the framework of which the 'critical' waste types are segregated from the retrieved waste and then the rest are - as far as possible - compacted before redisposal in the vaults. By doing so, the repository - which used up its capacity in 2004 - can continue to accommodate institutional radioactive waste from all over the country.

In order to provide the possibility of large scale waste retrieval, it is necessary for the long term to build a large, light structure hall which can ensure appropriate working conditions and satisfies the radiation safety and environmental protection functions necessary for the work. The radiation safety monitoring system has been extended.

2.8. RESEARCH AND DEVELOPMENT

2.8.1. R&D organizations

The Act on Atomic Energy stipulates that the safe use of nuclear energy must be aided by the development of science and technology, harmonized organization of research, practical implementation of domestic and international research results, and training of professionals. The coordination and assessment of R&D activities in the field of nuclear safety and security is the responsibility of the HAEA. In addition, the HAEA also finances activities aimed at supporting the regulatory oversight of the safe use of nuclear energy.

To maintain the quality of such a complex programme, the HAEA defined its basic principles and requirements for performing technical support activities. Scientific technical support is provided by a group of scientific technical institutions and other engineering organizations (TSOs). While details of the technical support activities are defined on a contractual basis, strategic partner agreements provide the opportunity to obtain quick, high level expert work free of charge. The HAEA has strategic partnership agreements with the Centre for Energy Research, the Nuclear Safety Research Institute (NUBIKI) and the BME NTI. The system of TSO partner agreements ensures that the HAEA has the appropriate engineering and scientific reserve capacities to handle situations which need fast and technically correct decisions.

To efficiently harmonize TSO cooperation, the HAEA developed a medium term R&D concept, which is regularly updated and determines the main areas of work for the upcoming period. The most important R&D areas for 2021-2024 include: support and modernization of the regulatory work; decommissioning and radioactive waste management; development of operational safety; nuclear emergency preparedness; and physical protection of nuclear facilities and radioactive waste storage facilities.

2.8.2. Development of advanced nuclear power technologies

Fast reactors are especially important from the point of view of sustainability of nuclear energy as a tool for closing the fuel cycle. The gas cooled fast reactor (GFR) also has potential to deliver high temperature heat for industrial processes and is considered an alternative reactor type to the sodium cooled fast reactor. The main R&D areas for GFR technology were identified in the Strategic Research Agenda of the Sustainable Nuclear Energy Technology Platform and the Concept Paper of the European Sustainable Nuclear Industrial Initiative.

The four respective nuclear research organizations of the Visegrad 4 region (ùJV Rež, Czech Republic; Centre for Energy Research, Hungary; National Centre for Nuclear Research - NCBJ, Poland; and VUJE, Slovakia) established the V4G4 Centre of Excellence in 2013 for the coordination of technical, experimental and other issues related to the preparation of the construction of the GFR demonstrator ALLEGRO. In January 2017, the French Alternative Energies and Atomic Energy Commission (CEA) joined the consortium as an associated member. A second Czech company, CV REZ joined the consortium as an associated member in January 2019. V4G4 launched the ALLEGRO project in July 2015. The first phase of the project aims to develop the conceptual design of the ALLEGRO reactor, addressing all safety related and other technical issues. The corresponding roadmap of the design work and safety analysis is under realization and the conceptual design has to be completed by 2025. To support these activities, a research, development and qualification roadmap is under preparation, providing a framework of the experimental work needed by the design and safety activities.

2.8.3. International cooperation and initiatives

In Hungary, both the licensees and the HAEA maintain wide ranging relations with various international organizations and other international forums, with other countries and institutions involved in the design, manufacture, installation and operation of nuclear facilities and with research institutes.

These relations serve as a means of exchanging knowledge and experience. The fact that Hungarian experts are held in high esteem internationally is demonstrated by their active role on different committees, with many of them being board members of international organizations or invited as experts.

Hungary has been a Member of the IAEA since 1957 and the Nuclear Energy Agency of the Organisation for Economic Co-operation and Development (OECD/NEA) since 1996.

Hungary has bilateral international agreements with Australia, Austria, Canada, Croatia, the Czech Republic, Germany, the Republic of Korea, Romania, the Russian Federation, Saudi Arabia, Serbia, Slovakia, Slovenia, Ukraine, the United States of America and Vietnam.

The HAEA has concluded memoranda of understanding on cooperation and mutual information exchange with regulatory authorities in Belarus, Bulgaria, the Czech Republic, Finland, Morocco, Poland, Romania, the Russian Federation, Slovakia, Türkiye, Ukraine and the United States of America.

Regional programmes organized by the European Union and the IAEA play an important role in cooperation between the regulatory authorities of neighbouring countries. Moreover, the HAEA is taking part in quadrilateral cooperation with the Czech Republic, Slovakia and Slovenia.

The HAEA takes part in several international cooperative activities, including the following:

  • International organizations:

    • IAEA;

    • OECD/NEA;

    • European Atomic Energy Community (Euratom);

    • Comprehensive Nuclear-Test-Ban Treaty Organization.

  • Multilateral cooperation:

    • Nuclear Suppliers Group;

    • Zangger Committee.

  • Nuclear forums:

    • ENSREG;

    • WENRA;

    • European Safeguards Research and Development Association;

    • European Nuclear Security Regulators' Association;

    • Heads of the European Radiological Protection Competent Authorities;

    • European Association of Competent Authorities;

    • Forum of the State Nuclear Safety Authorities of the Countries Operating WWER Type Reactors.

The Paks NPP is a member of several international bodies of major importance, including the World Association of Nuclear Operators (WANO), the WWER-440 operators' club, the WWER users' group, the International Nuclear Safety Programme (the so called Lisbon Initiative) and the Nuclear Maintenance Experience Exchange (NUMEX). Paks II Ltd is also a member of WANO.

PURAM takes part in activities of relevant international organizations (IAEA, OECD/NEA, etc.) and maintains bilateral contacts with other companies involved in radioactive waste management in other countries.

The Hungarian Nuclear Society is a member of the European Nuclear Society, and the Health Physics Section of the Eötvös Lorànd Physical Society is a member of the International Radiation Protection Association.

The TSOs of the HAEA take part in international activities, including the working groups of the OECD/NEA.

2.9. HUMAN RESOURCES DEVELOPMENT

The BME NTI operates a training reactor with a nominal power of 100 kW(th). Using this unique facility, the university has developed special nuclear education programmes for physics and energy engineering students at the undergraduate and postgraduate levels. A medical physics specialization of the physics Masters programme has also been available since 2010. The BME offers postgraduate nuclear training for engineers working or willing to work in the nuclear industry. Besides the traditional Reactor Technology postgraduate programme, a new postgraduate programme has been launched in 2020 at the BME. The four semester Nuclear Technology Management Programme - organized by the BME NTI and the BME's Faculty of Economic and Social Sciences - has received the endorsement of the IAEA. Special training courses for foreign students - with durations of six weeks to three months - are available at the institute.

There is a particle accelerator at the University of Debrecen, which is another resource for specialists in the field of nuclear sciences.

At the Faculty of Science of Eötvös Lorànd University, the students of the physics faculty also learn about nuclear techniques and practice at the Centre for Energy Research.

2.9.1. Paks Nuclear Power Plant

The Paks NPP has its own training organization, which operates a state of the art training infrastructure. The training organization provides initial and refresher training both for its own employees and contractor staff. The training system is operated on the basis of the IAEA systematic approach to training systems. Job specific training programmes and training materials are available for all the job positions related to nuclear safety. As part of the training infrastructure, there is a full scope replica simulator for operator training. For training the maintenance and technical support staff, a unique maintenance training centre is available, equipped with real primary circuit equipment such as a reactor vessel and its internals. The training organization cooperates broadly with national and international institutes and universities in the human resource development area.

2.9.2. Hungarian Atomic Energy Authority

At the HAEA, inspectors take part in a predefined training programme, which is reviewed annually. The training plan is divided into three parts: the training of newcomers, refresher training and specific training. The training plan also utilizes the results of R&D projects.

Newcomers to the HAEA also complete a special training course. It includes all important fields related to the HAEA's areas of responsibility, in addition to special training courses at the Paks NPP and at the other licensees. After having fulfilled the predefined training programme, the newcomers have to pass the inspector exam, in which they analyse real events regarding the licensing, supervision and investigation process of the HAEA.

The longer term training programme contains training directions based on the knowledge profile survey and on the future projects and strategy of the HAEA, such as bigger systems for the Paks NPP, lifetime extension at the Paks NPP, decommissioning, R&D projects and legal environment.

At the initiation of the director general of the HAEA, following thorough negotiations conducted in 2009, the representatives of Hungary's leading nuclear organizations established the Hungarian Nuclear Knowledge Management Database System on 22 June 2010 by signing a joint cooperation agreement at the HAEA headquarters. The main objective of the system is to collect and maintain the Hungarian documentation of the expertise accumulated during the application of atomic energy for future generations. This continually updated common database facilitates the sharing of knowledge and information within the nuclear community.

The code of conduct developed by the editorial committee was signed on 15 December 2010 and established the administrative conditions and the technical provisions for the operation of the knowledge management database. Consequently, the ordinary use of the 'common electronic repository' of the Hungarian nuclear community started in 2010. The uploading of documents is ongoing; the database currently consists of approximately 9 000 documents.

2.9.3. Paks II

It is important for the Paks II project to employ a highly qualified workforce; the Paks II Ltd established the Paks II Academy to support this goal. The educational offerings aim to provide different training for various levels of education. Within the framework of the Paks II Academy, a high quality post-graduate course is offered for engineers. Paks II Ltd compiled the curriculum and developed the training materials in cooperation with the Budapest University of Technology and Economics, the University of PÈcs, the University of Debrecen, the University of Pannonia, the University of Miskolc and the University of Dunaùjvàros. Together, these six universities launched the “Engineer/Specialist of Nuclear Power Plant Operations” post-graduate course and since 2020, further training for NPP specialists is also available. With the financial support of Paks II Ltd, the course is free of charge for participating students.

2.10. STAKEHOLDER INVOLVEMENT

In the area of stakeholder involvement, the HAEA is:

  • Arranging public hearings in all facility level licensing procedures to ensure transparency and openness;

  • Organizing “About Atomic Energy - to Everyone” student conferences, forums and meetings for other authorities, for licensees;

  • Publishing a wide range of documents on its web site, such as country reports (Convention on Nuclear Safety, Joint Convention), annual reports, pieces of legislation, guiding documents and all relevant news and events;

  • Publishing draft versions of guiding documents for public opinion;

  • Running a Facebook profile.

Owing to the COVID-19 pandemic in 2021 (and 2022), conferences have been cancelled, and other events have had to be organized online (e.g. electronic public hearings, electronic press conferences), or rescheduled (e.g. IAEA missions).

2.10.1. Public relations and information on the Paks Nuclear Power Plant

MVM Paks NPP Ltd frequently informs the public of events at the power plant via press releases. The press releases are also uploaded, together with other information materials, to the Hungarian and English web site of the NPP (atomeromu.mvm.hu and atomeromu.mvm.hu/en).

MVM Paks NPP Ltd has a Visitor Centre and a Nuclear Energetics Museum. Thanks to their programmes, the NPP remains a popular tourist destination. The Visitor Centre was established in 1995 and received over 30 000 visitors annually before the pandemic. The number of visitors in the Nuclear Energetics Museum, open since 2012, exceeded 25 000 per year prior to the pandemic. Due to the pandemic, both facilities have been closed.

The number of followers of the Paks NPP Facebook page is increasing year by year.

The Paks NPP organizes an annual 'open day' with various activities, which is popular with participants.

2.10.2. Public relations and information on the Paks II project

As a result of the COVID-19 pandemic, in 2020 Paks II Ltd shifted the focus of communication from personal contact to online communication. The Paks II Ltd's website was completely renewed in February 2020 and photo and video content was expanded. In 2021, since 22 April, Earth Day, the project company launched its Instagram and Twitter page as well.

The population next to the NPP site receives updated information about developments in the Paks II project. Among the local and regional media content, there has always been information about the project company's press conferences and the latest events regarding the project.

To inform the public, the project company's informative advertisements and public relations articles have been published in the county daily newspapers and local media, presenting the importance of nuclear energy and the Paks II project.

In the Paks NPP's Visitor Centre, an information corner for the new NPP units was set up in September 2016.

Through the so-called 'What's new, Paks II?', an A3 sized poster which addressed almost 70 settlements in the region in autumn 2021, the local population could learn about the most important events in the implementation of the two new NPP units from their settlement's billboards.

2.10.3.Public relations and stakeholder involvement of the Public Limited Company for Radioactive Waste Management

The primary purpose of the communication work of PURAM is to obtain, retain and reinforce the confidence and acceptance of the public to ensure that the existing and planned facilities can safely serve, for many decades and for the benefit of the country.

PURAM's regional communication task is to keep contact with and inform the stakeholders who live near the facilities. Thanks to the successful cooperation between PURAM and the local associations of the municipalities, PURAM receives help in organizing public events and school competitions, and publishing in local newspapers.

The other part of the communication strategy focuses on national and international relationships. PURAM has a showroom in Paks, next to the SFISF, and a Visitor Centre in Bàtaapàti, on the site of the NRWR, where PURAM also hosts civil and expert visitors.

PURAM has several brochures, publications and web site news stories, which also provide information about PURAM's activities. Additionally, PURAM conducts public opinion polls every two years, which can help to generate useful feedback about the general attitudes of the Hungarian public. PURAM managed a public opinion poll in 2021 all around the sites or investigation area. The results can help change the PR strategy of the company. One of the results was the need for social media, so PURAM strengthened this part of the communication strategy. In addition, several events were cancelled or held online. Site visits were also limited in 2021.

2.11. EMERGENCY PREPAREDNESS

2.11.1. Regulatory framework

Act No. 128 of 2011 on disaster management, and on the amendment of the related acts and its implementation laws, Govt. Decree 234/2011 (XI. 10) and Govt. Resolution 1150/2012 (V. 15) on the establishment, rules of organization and operation of the Disaster Management Interministerial Coordination Committee (DMCC) regulate the structure of the national disaster management system. This includes the prevention, preparation and response related tasks of the ministers and State organizations as well as the tasks of the disaster management coordination organization of the Government.

2.11.2. Operation of the Hungarian Nuclear Emergency Response System

The structure and tasks of the Hungarian Nuclear Emergency Response System (HNERS) are outlined in Govt. Decree 167/2010 (V. 11) on the national nuclear emergency response system. Under normal circumstances, organizations of the HNERS are in a state of readiness and carry out preparatory work and training. The concerned organizations perform ongoing tasks related to measurement data acquisition, information acquisition, radiological data exchange and planning, information or cooperation. In a potential nuclear emergency, it is the task of the Nuclear Emergency Response Working Committee of the DMCC to provide professional decision support. Within the affected installation, the person responsible for implementing tasks related to the response to a nuclear emergency is the chief executive of the installation; at the national level, it is the chairperson of the DMCC; while in the counties and in the capital, it is the chairperson of the regionally competent County (Capital) Defence Committees. The chairperson of the County (Capital) Defence Committee is the Government's commissioner, whose deputy is, as far as response to disasters is concerned, the management of the regional office of the professional disaster management organization. Among other tasks, the National Radiation Monitoring, Early Warning and Surveillance System (NRMEWS) is responsible for monitoring the radiation situation in Hungary, and it provides the information required for the decision support and decision making activities of the DMCC. The central body of the NRMEWS is the Nuclear Emergency Information and Analysis Centre working at the National Directorate General for Disaster Management of the Ministry of Interior. The tasks of the NRMEWS include the continuous monitoring, warning and verification of the national radiation situation, as well as supporting warnings and notifications according to the operating status of the HNERS by maintaining the early notification conditions of the national nuclear emergency response. In a nuclear emergency, it is the task of the HAEA to evaluate the nuclear safety and radiation conditions. Data and information for evaluation are provided by the Centre for Emergency Response, Training and Analysis (CERTA) operating within the organization of the HAEA and by the Nuclear Emergency Information and Analysis Centre operated by the National Directorate General for Disaster Management. Early detection tasks on the basis of monitoring of the national radiological conditions are fulfilled by the National Directorate General for Disaster Management. The nuclear emergency response related Real-time On-line Decision Support System for Nuclear Emergency Management (RODOS) also operates there, as well as the Hungarian Centre for the European Radiological Data Exchange Platform.

2.11.3. National Nuclear Emergency Response Plan

The HAEA operates a high level working group consisting of the State administration organizations concerned with the regular review of the Hungarian Nuclear Emergency Response Plan. The plan is approved by the DMCC. Currently, the most up-to-date version of the National Nuclear Emergency Response Plan is version 3.1, which was developed and finalized in the High Level Working Group at the end of 2019 and was submitted for approval to the chair of the Interministerial Coordination Body in March 2020.

3. NATIONAL LAWS AND REGULATIONS

3.1. REGULATORY FRAMEWORK

3.1.1. Regulatory authority(s)

The HAEA was established and empowered by the Act on Atomic Energy as the nuclear safety authority and was delegated the competence to perform regulatory tasks including: licensing, approving, inspecting, accounting, assessing, identifying and reviewing, and conducting enforcement procedures.

The HAEA's scope of competence comprises the regulatory oversight of nuclear installations, radioactive waste repositories and the safety and security of radioactive material in order to guarantee the peaceful and safe use of atomic energy all while serving the interests of the public as stipulated in laws, safety regulations and resolutions of HAEA.

Radiation protection (such as the oversight of X ray machines), general building authority and general building oversight in the safety zone of nuclear installations and radioactive waste repositories also fall within the scope and competences of the HAEA.

In the framework of its licensing activities, the HAEA confirms through licensing whether safety requirements are met by the licensees and the HAEA authorizes the licensee to carry out activities in relation to the use of atomic energy.

During its inspection activities, the HAEA examines compliance with all regulations contained in laws and licences, the implementation of measures imposed by the HAEA and whether nuclear energy is used for peaceful purposes. The HAEA regularly analyses and evaluates the activities of the licensees and the safety and security of nuclear facilities and performs analysis of events that have occurred. In case of an irregularity, the HAEA takes immediate measures for remediation.

The most important oversight tasks related to safeguards also fall within the scope of the competences of the HAEA, as the aim of non-proliferation of nuclear weapons includes the early detection of potential for misuse of nuclear material or technology; hence, its tasks include verifying those nuclear facilities are not misused and the production of nuclear material is not diverted from peaceful purposes.

In 2021, the National Assembly adopted a new act on the modification of the legal status of the HAEA, the objective of which was to introduce new regulation on the HAEA as an organization of special status, as well as to increase its independence, taking into account of the compliance with EU law. According to the new regulation, the President of the HAEA has the competence to issue regulations, allowing for a direct and efficient regulation in the nuclear field. The financial independence of the HAEA has been enhanced which allows the nuclear safety authority regulatory to offer competitive salaries and hire more highly qualified experts.

3.1.2. Licensing process

The basic principles of licensing procedures for NPPs, and the authorities taking part in licensing procedures, are regulated by Chapter 3 of the Act on Atomic Energy. To establish a new NPP, a new NPP unit or a radioactive waste repository, the preliminary consent in principle of the Parliament is required for starting preparatory work. To establish ownership of an NPP that is in operation or to transfer the right of operation, the decision in principle of the Government is required. According to the regulations in force, a licence is to be obtained from the authorities for all phases of operation (siting, construction, commissioning, operation and decommissioning) during the lifetime of an NPP. Moreover, a separate licence is to be obtained for all plant level or safety related equipment level modifications. Within the licensing procedures, technical aspects are enforced by legally delegated authorities. The authority takes account of opinions of legally delegated special authorities. When the installation of a new NPP is being considered, the precondition for launching the licensing procedure is the existence of an environmental protection licence. During the licensing procedure, the licensee prepares a preliminary environmental impact study. The environmental protection authority then sends the preliminary impact study to the relevant authorities to seek the opinion of authorities of potentially affected areas who in turn expose it to public view. The environmental protection authority, if it does not reject the detailed environmental impact study that has been submitted, subsequently holds a public hearing. Based on the detailed environmental impact study and on the responses received, the environmental protection authority may issue an environmental protection licence for the construction and operation of the plant.

The safety-related licensing of a nuclear installation takes place after the environmental licensing. The environmental protection authority acts as a special authority in the course of licensing a nuclear installation. During the licensing of installations and equipment and of their modifications, the contributing procedure of the environmental protection special authority provides the possibility for civil organizations to act as clients. The decisions of the nuclear safety authority are made public. Other licences to be issued based on Act No. 110 of 2001 on Electric Energy are also required to establish and operate a nuclear plant. Licences are valid for fixed periods; on request and provided that the necessary requirements are fulfilled, they may be extended. A licensee can appeal the decisions of the authority. It has the right to appeal in court.

Every ten years, a periodic safety review of the NPP is performed. Any decision on the further validity and conditions of the operating licence is made within the framework of the safety review.

3.2. NATIONAL LAWS AND REGULATIONS IN NUCLEAR POWER

3.2.1. Main national laws and regulations

Act No. 116 of 1996 on Atomic Energy (nuclear law, establishing responsibilities for different areas)

Decree No 24/1990 of 7 February 1990 of the Council of Ministers proclaiming the Vienna Convention on Civil Liability for Nuclear Damage of 21 May 1963

Government Decree No. 227 of 1997 (XII. 10) on the type, conditions and sum of the liability insurance or other liability financial coverage concerning atomic damage (civil nuclear liability)

Decree-law No. 12 of 1970 on the Treaty on the Non-Proliferation of Nuclear Weapons adopted on 12 June 1968 at Session XXII of the General Assembly of the United Nations

Decree-law No. 9 of 1972 on the promulgation of the agreement concluded between the Hungarian People's Republic and the International Atomic Energy Agency for the application of safeguards in connection with the Treaty on the Non-Proliferation of Nuclear Weapons, signed in Vienna on 6 March 1972(2)

Act No. 90 of 1999 on the confirmation and promulgation of the Additional Protocol signed in Vienna on 26 November 1998 in connection with the agreement for the application of the safeguards concerning the Treaty on the Non-Proliferation of Nuclear Weapons, concluded between the Republic of Hungary and the International Atomic Energy Agency and signed in Vienna on 6 March 1972

Act LXXXII of 2006 on the promulgation of the safeguards agreement and protocol on the implementation of Article III(1) and (4) of the Treaty on the Non-Proliferation of Nuclear Weapons, and on the Additional Protocol to the Agreement

(safeguards)

Decree-law No. 8 of 1987 on the promulgation of the convention on physical protection of nuclear materials

Act LXII of 2008 on the promulgation of the amendment to the Convention on the Physical Protection of Nuclear Materials, adopted by the International Atomic Energy Agency (IAEA) in 1979 and promulgated in Decree Law No 8 of 1987, signed on 8 July 2005 at the diplomatic conference organised by the IAEA

(security principles, including physical protection of nuclear material and facilities and protection of sensitive information)

Act I of 1997 on the promulgation of the Convention on Nuclear Safety adopted in Vienna on 20 September 1994 under the auspices of the International Atomic Energy Agency

Act LXXVI of 2001 on the promulgation of the Joint Convention on the Safety of Spent Fuel Management and on the Safety of Radioactive Waste Management under the auspices of the International Atomic Energy Agency

Resolution No. 4/2022 of HAEA on the rules of accountancy for and control of radioactive materials, and on the corresponding data provisions

Resolution No. 3/2022 of HAEA on the registration and control order of radiactive material and related data supply

Government Decree No. 144 of 2011 (VII. 27) on the regulation of the international transfer of nuclear and nuclear dual use items (import and export controls of nuclear material and items)

Decree No 28/1987 of 9 August 1987 of the Council of Ministers Convention on Early Notification of a Nuclear Accident, signed in Vienna, 26 September 1986

Decree No 29/1987 of 9 August 1987 of the Council of Ministers Convention on Assistance in the Case of a Nuclear Accident or Radiological Emergency, signed in Vienna, 26 September 1986

Gov. Decree No 165/2003 of 18 October 2003 on the rules for information to the public in nuclear and radiological emergencies

Gov. Decree No 167/2010 of 11 May 2010 on the national nuclear accident response system

Gov. Decree No 148/1999 of 13 October procedure 1999 proclaiming the Convention on Environmental Impact Assessment in a Transboundary Context, signed in Espoo, Finland on 26 February 1991

Gov. Decree No 314/2005 of 25 December 2005 on the environmental impact assessment and the uniform environment use authorisation

Decree No 93/1989 of 22 August 1989 of the Council of Ministers on the Revised Supplementary Agreement concerning the Provision of Technical Assistance by the IAEA, entered into force between the Government of the People's Republic of Hungary and the International Atomic Energy Agency on 12 June 1989

3.2.2. Laws and regulations related to the planned new nuclear units at the Paks Nuclear Power Plant

Act No. 2 of 2014 on the promulgation of the agreement about cooperation in the field of peaceful utilization of nuclear energy between the Hungarian Government and the Government of the Russian Federation (IGA)

Act No. 24 of 2014 on the promulgation of the agreement about the State loan provided to the Hungarian Government in order to finance the construction of the nuclear power plant in Hungary between the Hungarian Government and the Government of the Russian Federation (FIGA)

Act No. 7 of 2015 on the project on the capacity-maintenance of the Paks NPP and on the modification of related regulations

Government Decree No. 208 of 2015 (VII. 23) on declaring administrative matters relating to the maintenance of the capacity of the Paks Nuclear Power Plant and related investments to be of major importance for the national economy

Government Decree No. 94 of 2018 (V. 22) on the duties and powers of the members of the Government

Ministerial Decree No. 1 of 2018 (VI. 25) NVTNM on designation of entities exercising the owner rights and assuming the responsibilities over individual state-owned companies

3.2.3. Main regulations in the field of nuclear power

Government Decree No. 112 of 2011 (VII. 4) on the scope of activities of the Hungarian Atomic Energy Authority in connection with its international obligations, including the European Union, its authority and penalizing rights, the assignments of its coauthorities and on the Scientific Committee assisting the HAEA's activity (regulation for establishing an authorization system, responsibilities of the operator, inspection and enforcement)

Resolution No. 1/2022 of HAEA on the nuclear safety requirements for nuclear facilities and the procedures of the Hungarian Atomic Energy Authority in nuclear safety regulatory matters

Annex No. 1: Nuclear Safety Code, Vol. 1, Authority Procedures Applied to Nuclear Facilities

Annex No. 2: Nuclear Safety Code, Vol. 2, Management Systems of Nuclear Facilities

Annex No. 3: Nuclear Safety Code, Vol. 3, General Requirements for the Design of Nuclear Power Plants

Annex No. 3a: Nuclear Safety Code, Vol. 3a, Design Requirements for Nuclear Power Plants

Annex No. 4: Nuclear Safety Code, Vol. 4, Operational Safety Requirements of Nuclear Power Plants

Annex No. 5: Nuclear Safety Code, Vol. 5, Design and Operation of Research Reactors

Annex No. 6: Nuclear Safety Code, Vol. 6, Design and Operation of Spent Fuel Storage Facilities

Annex No. 7: Nuclear Safety Code, Vol. 7, Site Assessment of Nuclear Facilities

Annex No. 8: Nuclear Safety Code, Vol. 8, Decommissioning of Nuclear Facilities

Annex No. 9: Nuclear Safety Code, Vol. 9, Requirements for the Construction of New Nuclear Facilities

Annex No. 10: Definitions of Nuclear Safety Codes

Decree of the Minister of Health No. 16 of 2000 (VI. 8) on the execution of certain provisions of Act No. 116 of 1996 on Atomic Energy associated with radiation protection

Decree No 15/2001 of 6 June 2001 of the Minister of Environmental Protection on radioactive releases to the air and water during the use of nuclear energy and the monitoring of such releases

Decree No 7/2007 of 6 March 2007 of the Minister for Justice and Law Enforcement laying down rules for the registration and monitoring of nuclear substances

Government Decree No 246/2011 of 24 November 2011 on the safety zone of nuclear installations and radioactive waste repositories

Government Decree No. 215 of 2013 (VI. 21) on the designation, activity and funding of the organization performing certain tasks in relation to radioactive waste and spent fuel (radioactive waste and spent fuel management, including storage and disposal; decommissioning, including funding and institutional control of mining and milling)

Government Decree No. 190 of 2011 (IX. 19) on physical protection requirements for various applications of atomic energy and the corresponding system of licensing, reporting and inspection (physical protection)

Decree of the Minister of National Development No. 51 of 2013 (IX. 6) on the transportation, carriage and packaging of spent nuclear fuel

Gov. Decree No 215/2013 of 21 June 2013 on the designation and activity of the body carrying out certain duties related to radioactive wastes and spent fuel and the financing of such activity

Government Decree No. 155 of 2014 (VI. 30) on the safety requirements for facilities ensuring interim storage or final disposal of radioactive waste and the corresponding authority activities

Resolution No. 2/2022 of HAEA on on protection against ionizing radiation and the corresponding licensing, reporting (notification) and inspection system

Government Decree No. 489 of 2015 (XII. 30) on monitoring radiation conditions relevant for public exposure of natural and artificial origin and on the scope of quantities obligatory to be measured

Government Decree No. 490 of 2015 (XII. 30) on the reports and interventions regarding missing, found or seized nuclear and other radioactive materials and other actions pertaining to radioactive materials following their report

Resolution No. 7/2022 of HAEA on the registration of civil engineering-technical experts, civil engineering designers, technical building inspectors and responsible construction supervisors

Ministerial Decree No. 5 of 2015 (II. 27) BM of the Minister of the Interior on specific fire safety requirements associated with the application of atomic energy and on the method of their enforcement in the practice of authorities

REFERENCES

A detailed list of legislative acts governing the peaceful use of nuclear energy is available from the HAEA web site (www.oah.hu).

APPENDIX I: INTERNATIONAL, MULTILATERAL AND BILATERALAGREEMENTS

Multilateral and bilateral international agreements are available on the HAEA web site, as well as memberships in international organizations:

www.oah.hu/web/v3/HAEAportal.nsf/web?openagent&menu=03&submenu=3_6

www.oah.hu/web/v3/HAEAportal.nsf/web?openagent&menu=02&submenu=2_7

The most relevant laws and regulations in the nuclear field are also available on the HAEA website:

http://www.oah.hu/web/v3/haeaportal.nsf/web?OpenAgent&menu=03&submenu=3_0

APPENDIX II: MAIN ORGANIZATIONS, INSTITUTIONS AND COMPANIES INVOLVED IN NUCLEAR POWER RELATED ACTIVITIES

National nuclear energy authority
Hungarian Atomic Energy Authority
P.O. Box 676
1539 Budapest
Tel.: (+36) 1 436 4800
www.haea.gov.hu
Nuclear research institutes

Centre for Energy Research
29-33 Konkoly Thege Miklòs ùt.
1121 Budapest
Postal address:
P.O. Box 49
1525 Budapest 114
Tel.: (+36) 1 392 2222
Fax: (+36) 1 395 9293
www.ek-cer.hu
Institute of Nuclear Research
(ATOMKI Debrecen) of the Hungarian Academy of Sciences
P.O. Box. 51
4001 Debrecen
Tel.: (+36) 52 509200
Fax: (+36) 52 416181
www.atomki.hu
Nuclear Safety Research Institute
(NUBIKI)
P.O. Box 49
1525 Budapest
Tel.: (+36) 1 392 2700
Fax: (+36) 1 392 2701
Email: nubiki@nubiki.hu
www.nubiki.hu
National Research
Institute for Radiobiology and Radiohygiene
P.O. Box 101
1775 Budapest
Tel.: (+36) 1 482 2000
Fax: (+36) 1 482 2003
www.osski.hu
Power Engineering and Contracting Co.
(Pöyry-EROTERV)
P.O. Box 111
1450 Budapest
Tel.: (+36) 1 455 3600
Fax: (+36) 1 215 1854
www.etv.hu
Other nuclear organizations
MVM Paks Nuclear Power Plant Ltd
P.O. Box 71
7031 Paks
Tel.: (+36) 75 505 000
Fax: (+36) 75 506 634, (+36) 75 506 787
www.atomeromu.hu
Paks II Nuclear Power Plant Ltd
P.O. Box 116
7031 Paks
Tel.: (+36) 75 999 200
Fax: (+36) 75 999 242
www.paks2.hu
PLC for Radioactive Waste
Management (PURAM)
P.O. Box 12
7031 Paks
Tel.: (+36) 23 445 990
www.rhk.hu
Universities
Eötvös Lorànd University of Sciences
www.elte.hu
Budapest University of Technology and Economy
Institute of Nuclear Techniques
Muegyetemrkp. 9
1111 Budapest
Tel.: (+36) 1 463 2523
Fax: (+36) 1 463 1954
www.reak.bme.hu/en
University of Pannonia
Institute of Radiochemistry and Radioecology
Egyetem St. 10
8200 VeszprÈm
Postal address:
P.O. Box 158
8201 VeszprÈm
Tel./Fax: (+36) 88 624 178
Email: rri@almos.vein.hu
https://mk.uni-pannon.hu/index.php/english
University of Dunaùjvàros
Tàncsics Mihàly street 1
2400 Dunaùjvàros
Tel./Fax: (+36) 25 551 288
Email: international@uniduna.hu
www.uniduna.hu/en
University of Pècs
Vasvàri Pàl utca 4
7622 PÈcs
Postal address: 7602 PÈcs, Pf. 219
Tel.: (+36) 72 501 500
Fax: (+36) 72 501 508
Email: international@pte.hu
https://international.pte.hu

Coordinator Information
