SLOVAKIA
(updated on Nov. 2005)
1. ENERGY, ECONOMIC AND ELECTRICITY INFORMATION
1.1. General Overview
The size of the Slovak Republic is 49 036 km2 with 40% of the area situated up to the elevation of 300 m, 45% at the elevation between 300 and 800 m, and 15% at the elevation above 800 m. The lowest point is the mouth of Bodrog river at the elevation of 94 m and the highest situated point is Gerlachov peak at the elevation of 2655 m. Agricultural surface covers 49.9% from the entire Slovak territory, and forest surface 40.6%. The longest dimension in the east-west direction is 428 km and in the north-south direction 195 km. The Slovak Republic is a new country situated in the Central Europe. It was established on January 1, 1993. It is situated between 16ş50'04" and 22ş34'20" of east longitude, and between 47ş35'55" and 49ş36'54" of northern latitude (Fig. 1) in mild zone. The average annual temperature - a long-term average between 1901 and 1950 - is 10.1şC in Bratislava and the average rainfall is 670 mm. Table 1 shows typical parameters from the Meteorological stations Jaslovské Bohunice and Mochovce. In 2004, there were about 5 385 000 inhabitants and the density of the population was 110 inhabitants per km2. 2 170 400 people were economically active, out of which 641 300 in industry and 109 800 in agriculture.
FIG. 1. Map of the Slovak Republic |
TABLE 1. SELECTED PARAMETERS FROM METEOROLOGICAL STATIONS IN BOHUNICE AND MOCHOVCE
Parameter |
Unit |
Jaslovské Bohunice |
Mochovce |
Elevation above sea |
m |
176 |
261 |
Average annual temperature |
°C |
9.3 |
9.1 |
Average annual humidity |
% |
76 |
75 |
Average annual rainfall |
mm |
548 |
560 |
Dominant wind direction |
|
north-west |
north-west |
Wind velocity |
m/s |
3.4 |
1.7 |
The development of the gross domestic product (GDP) over the last ten years is shown in Fig 2. The 2004 Share of generating assests on total installed capacity is shown in Fig. 3.

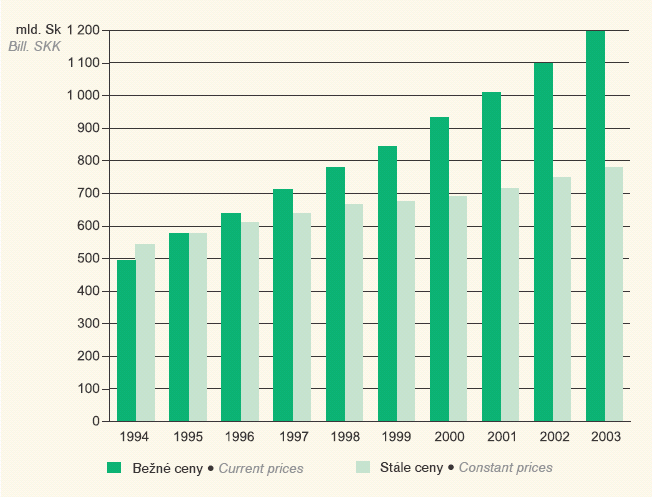

FIG. 2. Development of the GDP |

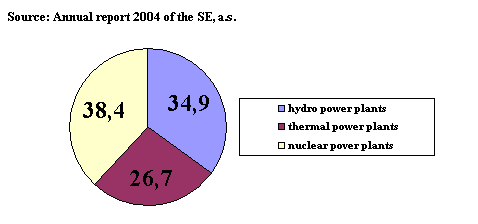

FIG. 3. Share of generating assests on total installed capacity(%) |
1.2. Energy Policy
The main goal is to achieve a necessary assurance in obtaining energy resources and to focus the Slovak energy economy on effective and environmentally friendly technologies of electricity generation, on higher use of renewables and secondary resources of energy, and on introduction of energy-saving production technologies and consumers, in which way a gradual reduction of the energy demands and of the absolute energy consumption will be provided.
The Energy Concepts for Slovakia till 2005 accepted by the Government decision No. 562/1993 define the principle objectives of and bases for the energy policy, analyze the current conditions of power economy and specify the strategy for assuring fuels and energy for the economy. These Energy Concepts were developed for the first time for the conditions of independent, national energy system. The philosophy of the concepts is based on a rational approach to both generation and consumption of electricity.
The Energy Concepts follow the concepts of industrial policy according to which the 1990 level of energy consumption will be reached between 2000 and 2003. A gradual restoration of the economic growth is expected with the increase of electricity consumption by approximately 2% annually. The approach to the assurance of resources that will meet the requirements of consumption has been changed drastically.
The fundamental strategic goal of the energy policy is to ensure fuel and energy for all consumers. The energy shall be:
One of energy policy priorities is to restore sound environment by reducing emissions of polluting materials in line with the accepted multilateral Convention on Remote Atmosphere Pollution from 1979 in Geneva, the protocols from Helsinki and Sofia on reduction of SO2 and NOx emissions, as well as the Declaration from The Hague. The following commitments resulted for Slovakia from the above documents:
These specified tasks (only I) and ii)) in the power industry have been fulfilled up to now and there are expectations for their further successful fulfillment within the framework of the accepted "Energy Concepts of the Slovak Republic till 2005". Table 9 shows the emissions of steam power plants from SE a.s.
TABLE 9. EFFLUENTS INTO THE ENVIRONMENT FROM STEAM POWER PLANTS OF SE
Pollutant |
1990 |
1993 |
1995 |
2000 |
2001 |
2002 |
SO2 |
184,2 |
104,6 |
69,6 |
40,1 |
52,7 |
41,3 |
NOx |
31,5 |
24,7 |
25,3 |
21,4 |
18,7 |
12,3 |
CO2 |
7987 |
7510 |
6811 |
5310 |
5947 |
4687 |
Solid
Pollutants (TZL) |
56,7 |
13,9 |
10,6 |
8,5 |
8,0 |
6,7 |
The fundamental document, defining main targets, directions and framework of power development, is the Power Policy of the Slovak Republic approved by the Slovak government decree No. 5 dated 12 January 2000.
The power policy defines the framework for new orientation of the power sector and has three pillars:
The main target of the preparation for integration into the EU internal markets is transformation of the power sector into a compatible one that is able and prepared to be incorporated into a united European market. The power sector transformation is conditioned by meeting the basic measures: restructuralization and privatization of power utilities, establishment of independent regulatory authority, making energy prices more realistic for all categories of consumers, completion and approval of legislation adapting power sector.
The intentions of the power policy are as follows:
Another important measure related to nuclear power sector is the governmental decree on the closure of the two oldest units at the Bohunice V-1 nuclear power plant (EBO) in 2006 and 2008, respectively. By implementing a programme of modernization and safety upgrading of the V-2 Bohunice nuclear power plant, extension of the V-2 design lifetime will be enabled with the high level of safety maintained. The decision on the completion of Mochovce units 3 and 4 will depend on the interest of a strategic partner, as no guaranty of the state is possible.
In the field of electric power sector it is expected that a major part in the increase of electricity demand will be covered by developing the production of independent generators, mainly based on steam-gas cycle.
The development of heat supply systems, based mainly on centralized methods of heat supply for communal consumption and industrial technology processes, will depend on accelerated elimination of deformations in the prices of electricity and natural gas. The process of making these prices more realistic has been already launched according to a time schedule accepted. A profitable geography position and significant location of Slovakia in regard to transit of natural gas through its territory into Western Europe create good preconditions for building a "Gas Centre" with European-wide importance. Notwithstanding the high level of reliability of gas supply from the Russian Federation, it will be necessary to look for possibilities in diversification of gas imports from other territories. A similar suitable situation relates to the strategic assurance of oil imports. In line with EU legislation and with a bill under preparation on mandatory reserves of oil products, capacities for the storage of mandatory oil reserves (90-day reserve) will be gradually built. Based on a government decision to use preferentially for electricity production (up to the amount of 10% from total electricity consumption) domestic brown coal, that is the only significant fuel source, gradual extraction of coal and lignite resources in line with mining capabilities will be made possible. Protection of the environment is one of determining factors of the power policy. The legislation framework in effect and international obligations of Slovakia in the area of reduction of the production of emission materials provide the starting point for the acceptance of programs for emission reduction and increased utilization of renewable resources. For the implementation of these programs, coordinated progress of a number of industrial sectors and incorporation into practice of system measures in the field of tax and price policies, ecology and legislation is needed.
2. NUCLEAR POWER SITUATION
2.1. Historical Development and current nuclear power organizational structure
2.1.1. Overview
Brief overview of main
decisions and events related to the implementation and development of the
nuclear programmes is given as follows.
A-1
Bohunice:
1956
Intergovernmental agreement between the former USSR and CSSR on the construction
of an industrial-research nuclear power plant on the territory of CSSR.
1957 Establishment
of an investment enterprise Nuclear Power Plant A-1 by the decision of the
Governmental Committee for Nuclear Energy and of the Authority for Nuclear Power
Management.
1958 Beginning of A-1
construction.
1972 The research
and development reactor KS 150 at A-1 reached criticality. Gradual increase of
the electric output up to the maximum value of 127 MW. Connection of A-1 to the
electric grid.
1976 First serious
incident at the KS-150 reactor.
1977 The decisive
severe accident during reactor refuelling.
1978 Decision of CSSR
government to decommission A-1.
1992 Slovak government
accepted the global concepts and schedule of A-1 decommissioning.
1999 UJD issued
decision No. 137/1999 - approving decommissioning plan for decommissioning NPP
A-1 - Stage 1 - scheduled till 2007 - plant status will be - all spent fuel
permanently removed from the plant, majority of liquid RAWs adjusted to a form
enabling safe final disposal; all remaining RAWs treated to a form enabling
their safe permanent disposal or long-term storage; the necessary
decontamination of premises and rooms performed.
1999 Last two
transports of spent nuclear fuel took place - all spent fuel produced during the
operation has been transported from the site back to the Russian Federation.
V-1 Bohunice:
1969 Decision of
the State Planning Commission of CSSR based on an agreement with USSR to start
the construction of nuclear power plants with pressurized water reactors of VVER
440 type.
1970 Decision of
CSSR and USSR governments to supply two nuclear power plants each with two VVER
reactors 440 MW.
1971 Establishment of
affiliated organization in Jaslovské Bohunice.
1973 Laying of
foundation stone for the construction of main production building.
1978 V-1 Unit 1
reactor made critical.
1979 Commissioning of
V-1 Unit 1 into trial operation.
1980 Commissioning
of V-1 Unit 1 into commercial operation. V-1 Unit 2 reactor made critical.
Commissioning of V-1 Unit 2 into trial operation.
1981 Commissioning of
V-1 Unit 2 into commercial operation.
1984 Re-evaluation of
V-1 safety.
1986 Other safety
measures to enhance nuclear safety.
1990 Execution of
reviews to evaluate V-1 conditions.
1991 CSKAE Decision
about V-1 operation based on implementation of additional safety measures.
1991-1995
Implementation of Phase 1 measures to upgrade safety by backfitting V-1 units.
1995-2000
Implementation of Phase 2 measures with the objective to achieve European
standards and maintain V-1 in operation.
2001 ÚJD issued
decisions No. 144 & 220/2001, approving further operation of Unit 1&2.
V-2 Bohunice:
1976 Agreement
signed with USSR on the construction of V-2 in Jaslovské Bohunice. Beginning of
V-2 construction.
1984 V-2 Unit 1
reactor made critical. Commissioning of V-2 Unit 1 into trial operation.
1985 Commissioning
of V-2 Unit 1 into commercial operation. V-2 Unit 2 reactor made critical.
Commissioning of V-2 Unit 2 into trial operation. Commissioning of V-2 Unit 2
into commercial operation.
2000-2001 Concept
of modernization and safety upgrading elaborated – approved by UJD decisions
No. 214/2000 and No. 250/2001.
Mochovce:
1974 Preparatory
studies, survey works, sociology survey.
1978 Federal
Ministry of Fuel and Power approved an investment intention to construct two
twin-reactor units with the capacity of 440 MW each.
1981 Physical start of
Mochovce construction.
1983 Establishment
of a concern enterprise Atomic Power Plants Mochovce with its headquarters in
Mochovce.
1989 The original
deadline for Mochovce Unit 1 commissioning failed to be met due to necessary
replacement of inadequate instrumentation and control system.
1995 The way of
funding the construction of Mochovce Units 1 and 2 was still open, construction
and installation works continued in a minimum extent only. (The funding of
Mochovce completion was resolved by the Government Decision No.339/96 dated May
14,1996).
1998 Commissioning of
Unit 1 - reactor reached first criticality on 9. 6. 1998
1999 Unit 1 in
commercial operation since 23. 4. 1999.
Commissioning of Unit 2 - reactor reached first criticality on 1.12.1999.
2000 Unit 2 in
commercial operation since 31.10.2000.
Government decree -
257/2000 - government did not suspended the completion of the construction of
units 3 and 4; rather it decided to abstain from granting sovereign guarantees
for loans to be used to finance the completion (construction frozen since
1994).
2.1.2. Current Organizational Chart(s)
Under Act No. 541/2004 Coll.
on peaceful uses of nuclear energy, the supervision of peaceful use of nuclear
energy is performed by government authorities within their competencies laid

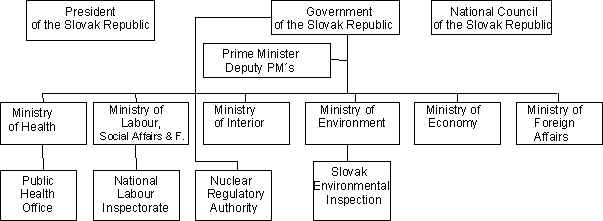

down in the relevant acts by the scheme shown in the following figure.

Fig. 4. Slovak Institutions involved in the nuclear sector |
Nuclear installation
licensing procedure
The licensing procedure
consists of three major stages: sitting, construction, commencement and
permanent operation. Before granting a licence for permanent operation, the
regulatory authority carries out control under the approved programs for hot and
cold testing and grants approval for fuel loading, physical start up, energy
start up and trial operation..
The basic condition essential
to licensing in terms of nuclear safety is to prepare and submit a Safety
Analysis Report and other prescribed safety documentation and to meet the
conditions of the regulatory authority’s preceding licensing procedures and
decisions.
Till the end of November 2004,
regional offices issued their decisions on sitting, construction, operation and
decommissioning of nuclear installations following permission from UJD, the
Public Health Office of the Slovak Republic, labour inspection authorities and
other state administration authorities and organisations (see the figure below).
On 1 December 2004 new Atomic Act No. 541/2004 Coll. came into effect, giving
the UJD competencies in issuing decisions/ permits on construction and
operation of nuclear installations. In that case the regional office in the
figure is replaced by UJD.
A licence holder is
responsible for the safety of a nuclear installation.
2.2. Nuclear Power Plants: Status and Operations
Slovenské Elektrárne a joint stock company is the largest electricity generation company in the Slovak Republic. In point of nuclear, the Company operates Bohunice nuclear power plant (4 units) and Mochovce nuclear power plant (2 units) with total installed capacity of 2 640 MW.
Bohunice
The Bohunice power plant comprises four nuclear reactors configured in two twin units, V-1 and V-2, which are situated at Bohunice, approximately 60 km northeast of the Slovak capital, Bratislava. Each reactor drives two 220 MW Skoda generators, providing a combined plant capacity of 1,760 MW. The Bohunice V-2 plant also supplies up to 170MWth of heat.
The two V-1 reactors are pressurized water reactors
VVER-440/V230 of Soviet design, which were significantly upgraded mainly in two
safety improvement programs between 1990-2000.
The two V-2 reactors are of improved pressurized water
reactors VVER-440/V213, currently under stepwise (during annual outages)
implementation of major modernization and safety upgrading program.
Mochovce
The Mochovce NPP is situated in the south of Slovakia near the town Levice. Two reactors, Unit 1 and Unit 2 each drives two 220 MW Skoda generators, providing a combined plant capacity of 880 MW. Design bases is improved comparing to similar NPPs by implementation of number of safety measures, mainly before plant commisssioning (addressing safety issues of higher safety significance) or within first years of operation (safety issues of lower safety significance). No heat is supplied to external industries or district heating from Mochovce site.
Construction of two further units, 3&4, has been
suspended in middle 90-ties. By its Resolution No. 257/2000 of 19 April 2000,
the Slovak Government did not suspended the completion of the construction of
NPP Mochovce units 3 and 4; rather it decided to abstain from granting sovereign
guarantees for loans to be used to finance the completion. In this way,
the option of NPP Mochovce 3 and 4 being completed by foreign investors and/or
foreign investors participating in the power energy privatization process
through investments into units under construction has not been ruled out, and
SE, a.s. was given the opportunity to officially negotiate with potential
investors.
With a view to distinguish the cost for the energy
production on units 1 and 2 from the costs connected with the possible
completion of units 3 and 4, SE, a.s.´s Board decided to establish
a new branch plant of SE termed Mochovce Units 3 and 4 (acronym SE-MO34). The
scope of SE-MO34´s activities includes activities such as administration
and conservation of units 3 and 4.
2.2.1. Status of nuclear power plants

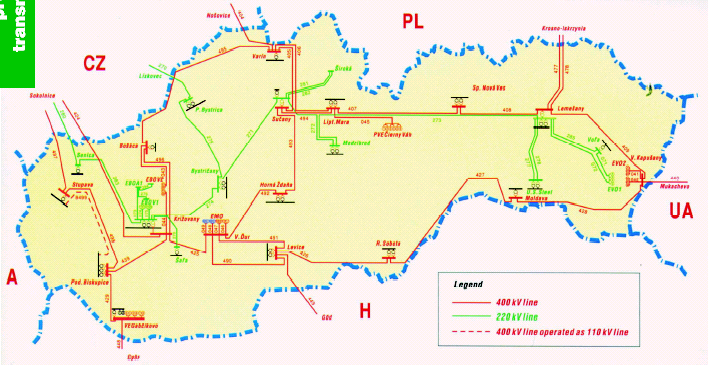

Transmission system of Slovak Republic
map of powerplants: http://www.seas.sk/power-plants/
TABLE 14. STATUS OF NUCLEAR POWER PLANTS
Station |
Type |
Capacity |
Operator |
Status |
Reactor |
BOHUNICE-1 |
VVER |
408 |
EBO |
Operational |
AEE |
BOHUNICE-2 |
VVER |
408 |
EBO |
Operational |
AEE |
BOHUNICE-3 |
VVER |
408 |
EBO |
Operational |
SKODA |
BOHUNICE-4 |
VVER |
408 |
EBO |
Operational |
SKODA |
MOCHOVCE-1 |
VVER |
388 |
EMO |
Operational |
SKODA |
MOCHOVCE-2 |
VVER |
388 |
EMO |
Operational |
SKODA |
MOCHOVCE-3 |
VVER |
388 |
EMO |
Construction Postponed |
SKODA |
MOCHOVCE-4 |
VVER |
388 |
EMO |
Construction Postponed |
SKODA |
A-1 BOHUNICE |
HWGCR |
110 |
EBO |
Under Decommissioning |
SKODA |
Station |
Construction |
Criticality |
Grid |
Commercial |
Shutdown |
BOHUNICE-1 |
01-Apr-74 |
27-Nov-78 |
17-Dec-78 |
01-Apr-80 |
|
BOHUNICE-2 |
01-Apr-74 |
15-Mar-80 |
26-Mar-80 |
01-Jan-81 |
|
BOHUNICE-3 |
01-Dec-76 |
08-Aug-84 |
20-Aug-84 |
14-Feb-85 |
|
BOHUNICE-4 |
01-Dec-76 |
02-Aug-85 |
09-Aug-85 |
18-Dec-85 |
|
MOCHOVCE-1 |
01-Oct-83 |
09-Jun-98 |
04-Jul-98 |
13-Oct-98 |
|
MOCHOVCE-2 |
01-Oct-83 |
01-Dec-99 |
20-Dec-99 |
11-Apr-00 |
|
MOCHOVCE-3 |
01-Jan-85 |
|
|
|
|
MOCHOVCE-4 |
01-Jan-85 |
|
|
|
|
A-1 BOHUNICE |
01-Jan-58 |
01-Jan-72 |
01-Oct.-72 |
01-Dec-72 |
17-May-79 |
Source: IAEA Power Reactor Information System as of 31 December 2004. |
2.2.2. Performance of NPPs
Slovenské Elektrárne, joint stock company is the largest electricity
generation company in the Slovak Republic. At present the Company does not have
a monopoly position, but remains to be a dominant producer of electric power in
the Slovak Republic. The Company owns and operates a power generation portfolio
of 6,881 MW in Slovakia (by the end of 2003), of which 38% are in nuclear power
plants, 27% in conventional thermal power plants and 35% in hydro power plants.
Bohunice and Mochovce units have been operating according to yearly, mothly,
weekly and daily plans agreed with Slovak trasmission lines company and actual
requirements of Slovak dispatching center, depending on current power
consumption and status and needs of the energy system. Nuclear units were
basicaly operated in following regimes:
· base load
at full nominal power,
· load
reduction in tertiary regulation of active power (between 50-90% of nominal
power), mainly during weekends and in summer time;
· in
addition, Bohunice V-1 and V-2 units were operated in primary control of active
frequency (with power reduced to 96-97%), and the V-2 units also in secondary
control of active power (with power reduced to 93%.
Plants were designed to allow thermal cycling
bound with above load changes. Their impact on ageing (mainly due to fatigue
reasons) of main reactor coolant system components is annually calculated, based
on actual unit data records and evaluated taking into account their residual
life time.
Plant availability of Slovak nuclear units is
comparable with WANO average value. UCF and UCLF values in 2003 are given in the
table. In point of UCLF, results have been successful, except of Mochovce unit
1. The reason of relatively high unplanned capability losses was the fact that
the unit was shutdown (for 16 days) immediately after planned outage for
refueling, because of unsealing two out of four rings of main reactor pressure
vessel flange.
|
EBO 1 |
EBO 2 |
EBO 3 |
EBO 4 |
EMO 1 |
EMO 2 |
WANO PWR average 2003 |
UCF |
88,10 |
80,02 |
78,28 |
87,76 |
82,95 |
87,75 |
82,41 |
UCLF |
0,45 |
0,55 |
0,13 |
0,37 |
5,21 |
0,51 |
3,7 |
In 2003 Nuclear Power plants in Slovakia generated 17
863,9 GWh, from that Bohunice 11 625,4 GWh and Mochovce 6 238,5 GWh. It
represents 68,6% of the SE company generation or 57,4% of the total
generation in Slovakia.
Table 13 presents some basic operating data and Table 14
shows the status of nuclear power plants in the Slovak Republic. The costs of
one MWh delivered from all units include also contribution to the State Fund for
Decommissioning of Nuclear Power Installations - 350 000,- SKK per installed MW
and 6,8 per cent of revenues comming from actual electricity supplied.
TABLE 13. BASIC DATA OF OPERATING NPPs
|
Production
(TWh) |
Load factor (%) |
||
Unit |
2003 |
Since
commiss. |
2003 |
Cumulative |
EBO 1 EBO 2 EBO 3 EBO 4 EMO 1 EMO 2 |
2,77 2,61 2,48 2,81 2,80 2,96 |
67,63 66,43 55,96 54,57 15,30 11,32 |
77,36 73,72 76,28 78,76 78,83 83,57 |
71,86 73,72 76,28 78,02 75,2 75,26 |
|
|
|
|
|
2.2.3
Plant upgrading and plant life management
Reactor
Type V-1
2x440
MW VVER V-230
Based on recommendations from IAEA and EC experts, the
so called "small backfitting" of V-1 was carried out between 1991 and
1992, with the costs of 2 million Sk, and focused mainly on:
•
improving confinement integrity;
•
upgrading seismic resistance;
•
analyzing reactor pressure vessel life;
•
backfitting fire protection systems;
•
annealing reactor pressure vessels;
•
installing another diesel generator and new distributions of essential power
supply;
•
verifying validity of the "leak before break" (LBB) principle at
reactor coolant system. The implementation of these actions was a prerequisite
for the operation of the V-1 plant till 1995. According to the ÚJD SR Decision
No.1/94, the prerequisite for further operation after 1995 was to implement the
so called "gradual upgrading" between 1996 to 2000 with the costs of
8.000 million Sk. The content of this extensive backfitting program included
among others following:
•
further improvement of confinement integrity;
•
modifications of core cooling during both operation and loss of coolant
accidents;
•
modifications of emergency power supply for cooling systems and introduction of
off-site emergency power supply from the near-by hydroelectric power plant;
•
replacement of the reactor protection system for a new digital one TELEPERM
XS and significant improvements of other instrumentation and control systems;
•
improvement of fire resistance;
•
enhancement of the levels of quality assurance, safety, operating procedures,
documents for personnel training, emergency planning etc.
The
gradual reconstruction was implemented in line with the schedule approved by the
UJD SR. It was partly performed during normal operation of V-1 units, but mainly
during planed unit refuelling outages and overhauls. The outages were extended
depending on the extend of the upgrading works to be performed. The program was
accomplished by Unit 1 start-up in June 2000. The IAEA Review of Major Upgrading
Results at Bohunice WWER-440/230 NPP Units 1 and 2 held in November 2000 on
invitation of the Slovak government stated that:
Comprehensive
and well justified safety upgrading program has been developed and
implemented.
The
program defines new safety case which satisfies the Slovak national
requirements – coping DBA – LOCA 2x200 mm (conserv. app.), BDBA – LOCA
2x500 mm (best estim. app.).
All
IAEA recommendations for WWER-440/230 type of reactors were addressed,
intent of recommendations is met, in some areas measures go even beyond
expectations.
The
completion of the reconstruction works resulted in a significant
improvement of NPP V-1´s nuclear safety standard, thus achieving the
internationally acceptable standards of safety and operating reliability.
Based
on the IAEA safety review as well on their own assessment UJD issued decisions
No. 144/2001 and No. 220/2001, approving further operation of Unit 1 and 2.
Operational
safety of NPP V-1 was further enhanced by implementation of symtom based
emergency operating procedures, which were put in place in December 2003. These
procedures were developed, similarly as for Bohunice V-2 and Mochovce NPP, in
co-operation with Westinghouse Electric Europe.
However
during negotiations on Slovak accession to the EU, the Slovak government decided
to close the V-1 Unit 1 in 2006 and the V-1 Unit 2 in 2008.
Reactor
Type V-2
EBO
- 2 x 440 MW VVER 213
Most
extensive long-term program of SE, a.s. is currently being implemented at Unit 3
and 4 at Bohunice, with planned investment costs more than 10 bil. Sk. Schedule
and content of tthis „NPP Bohunice V-2 Units Upgrading and Safety Improvement
Program“ was approved by UJD decisions No. 214/2000 and No. 250/2001. The aim
of this program is to increase the level of safety of NPP V-2 according to the
IAEA recommendations for the WWER-440/213 reactor design, as defined in the IAEA
EBP-WWER-03 document „Safey Issues and their Ranking for WWER-440/213 NPPs“,
April 1996. The UJD decisions stipulate the operator to implement measures to
solve:
issues
of category III till the end of 2004,
issues
of category II till the end of 2006,
other
measures defined in the safety concepts submitted to the UJD till the end of
2008.
Modifications
and safety measures are focused mainly on:
•
modification of reactor coolant system, safety systems, essential power supply,
instrumentation and control system (including replacement of reactor protection
system);
•
strengthening of seismic resistance;
•
improving of fire protection efficiency;
•
qualification of equipment and components;
•
installation of new ventilation systems and new steam dump stations on main
steamgenerators steam lines;
•
reinforcements of bubbler condenser systems;
•
enhancement of the levels of quality assurance, safety, operating procedures,
documents for personnel training, emergency planning etc.
Extension
of the NPP Bohunice V-2 units lifetime to a minimum of 40 years, in
accordance with the production and technological base development plan of SE,
a.s. and increasing of units nominal output (from reserves and through improved
efficiency of the units) is also a subject of the modernization program.
EMO
- 2 x 440 MW VVER 213
A comprehensive
safety upgrading program was implemented also at both units of Mochovce NPP. The
classification of the individual safety-relevant issues was based on the IAEA
document EBP-WWER-03 „safety Issues and their Rankking for WWER-440/213 NPPs“
with the difference that the extent of safety-relevant measures has been
extended by the recommendations of RISKAUDIT, taking into account specific
conditions of the NPP Mochovce.
The
results of safety measures are documented in the Safety Assessment Report or in
other supporting documents.
Before
start up of the units safety issues of categories III and II have been addressed
in a manner to fulfill requirements of INSAG 3 from the point of view of
defense i depth concept.
The
remainig safety measures were implemented depending on the technological
possibilities during the operation and if such measures required unit shutdown,
their implementation was postponed to refueling outages. This procedure was
continuously approved and verified by UJD.
The
safety improvement program was evaluated after the completion of units 1 and 2
shutdown in 2001. The evaluation confirmed that the implementation of safety
measures adopted within the safety improvement project which was a part of
the completion of units 1 and 2 has been principally completed.
The
implementation of the last remaining safety measure “Post Accident Monitoring
System“ was finished according to the schedule at Unit 2 in 2003 and on
Unit 1 in June 2004.
2.2.4
Nuclear power development projections and plans
According
to the current status of nuclear in the Slovak Republic, there is not an
intention to build up any other nuclear power units generating electricity,
except of Mochovce unit 3 and 4. As it was mentioned, the Slovak
Government did not suspend the completion of the construction of NPP Mochovce
units 3 and 4. The main possibility, how to accomplish construction of units 3
and 4 is cooperation with foreign investors. After decision of the Slovak
government to privatize a 66% share of SE, the winner of the bid, i.e. the
Italian company ENEL shall prepare a strategic investment plant to replace
energy sources to be shut down in the near future. Analysis of completion
of units under construction in Mochovce is to be also part of this strategic
plan.
2.2.5.
Decommissioning: information and plans
Basic
legislation on decommissioning in Slovak Republic is given by
Law
no. 541/2004 Coll. on Conditions of Peaceful Use of Nuclear Energy (”Nuclear
Act”) and Law no.127/1994 Coll. on environment impact assessment. The operator
is responsible for decommissioning of nuclear facilities.
NPP
Decommissioning conception in SR
There
are three basic scenarios considered in the decommissioning conception:
·
NPP decommissioning up to I. degree - the closing with surveillance
·
NPP decommissioning up to II. degree - with reactor safe enclosure
·
NPP decommissioning up to III. degree - to green-field
NPP
A-1 decommissioning conception:
There
were available three potential scenarios:
1.Continuous
decommissioning scenario
2.
Nuclear island safe enclosure scenario
3.
Reactor safe enclosure scenario
The
”Continuous decommissioning scenario” for NPP A-1 was recommended based on
technical-economic assessment and considered as the most suitable from these
evaluated scenarios. It will be ended by removing of the NPP and by release of
the site for an unlimited using.
NPP
A-1 decommissioning consists of two fundamental time phases:
A.
operation termination after reactor shutdown - since shutdown in 1977 until 1999
Project design for NPP A-1 decommissioning was elaborated (1995-1999)
Official License for A-1 decommissioning was issued by ÚJD SR in 1999.
B.
A-1 decommissioning - the time phase after 1999 until 2033 or 2056 based on the
selected scenario, that involves two periods of A-1 decommissioning:
·
1. period of decommissioning NPP A-1 since 1999 until 2007: can be characterized
as follows - all spent fuel has to be removed from the site, majority of liquid
RAW has to be treated to yield a form enabling safe permanent storage, other RAW
have to be adjusted to yield a form enabling safe permanent disposal or
long-term storage, necessary decontamination to reduce further potential sources
of radioactive leakage should be performed;
·
2. period of decommissioning NPP A-1 after 2007: it presents the dismantling and
liquidation of NPP A-1 and the release of the site for an unlimited using (to
green-field)
NPP
with VVER 440 units decommissioning conception (Bohunice V-2 and Mochovce):
At
first the document on decommissioning of NPP with VVER 440 units has been
elaborated. Based on the comparing of the individual decommissioning scenarios
and using the multicriterial analyses, the decommissioning to the I. degree (the
closing with surveillance for 30 years) and subsequent dismantling and
liquidation of NPP to green-field resulted as the most suitable scenario.
In
this case the NPP VVER 440 decommissioning, after the termination of operation
consists of two following periods:
·
1. period of decommissioning: the condition establishing and the operation of
the plant in the state “the closing with surveillance“ for the time of 30
years
·
2. period of decommissioning: the dismantling and liquidation of NPP and the
release of the site for an unlimited using (to green-field)
NPP
JE V-1 decommissioning conception
Based
on the Government decree (resolution) No. 801/1999 units V-1 will be shutdown in
2006 and 2008. Subsequently the termination of operation will be finished till
December 2011, when all spent fuel will be removed from reactors to the
intermediate spent fuel storage facility.
For
NPP V-1, based on the study on the site exploitability, three possible scenarios
of NPP decommissioning are to be analyzed according to the Law no.127/1994 Coll.
on environmental impact assessment. The utility currently recommends so-called
speeded up process of decommissioning from 2012 till 2025. However the final
decision has not been made yet and it will also depend on the environmental
impact assessment and on the decision of the government.
2.3. Supply of NPPs
The main domestic producer and supplier of selected components of pressure
systems (separators, piping, heat exchangers) for nuclear power plants is the
Slovak Power Engineering Works (SES) in Tlmace and the Piping Company in Kosice.
The supplier of civil construction works has been the Hydrostav Bratislava. The
main foreign suppliers are Atomenergoexport (Russia), ŠKODA, Vítkovice
ironworks and EGP (Czech Republic). Well-known Western firms (EdF, Framatome ANP)
have been cooperating with them and with VUJE, a.s. company during Mochovce
completion and Bohunice safety upgrading programs.
2.4. Operation of NPPs
The owner of the Bohunice and Mochovce plants is the utility Slovenské
elektrárne, a.s. (SE). The operators of these six units are SE affiliations
Nuclear Power Plants Bohunice (EBO) and NPPs Mochovce (EMO). The Nuclear Power
Plants Bohunice have built their own technical and professional capacities for
the performance of maintenance activities. The execution of specialized
activities is ordered by EBO and EMO from manufacturers of these components, or
from specialized firms. The training of nuclear personnel, i.e. operators and
maintenance and decommissioning personnel, is carried out by the Training Center
in the VÚJE Trnava, Inc. – Engineering, Design and Research Organization. VÚJE
performs professional, practical and theoretical training of nuclear power plant
personnel in six categories based on the Certificate No. 1/94 from the ÚJD SR.
The Category 1 is designed for selected personnel, e.g. operators, control
physicists and reactor unit supervisors. Following successful graduation from
theoretical and practical training, trainees obtain certificates. For the
performance of a function, the Category 1 personnel have to obtain a ÚJD
license that has to be renewed each two or three years depending on the
function.
2.5. Fuel Cycle and Waste Management
All the fuel for the operation of six VVER 440 units in
Slovakia has been fabricated in the Russian Federation. The fuel supplier
provides completed fuel assemblies, including nuclear material, its conversion
and enrichment. In the present time Slovenske elektrarne has two fuel contracts.
One fuel contract is valid for Bohunice units 1 and 2 to the end of their
operation (2006, resp.2008) and till the end of 2005 for Bohunice units 3 and 4
and Mochovce units 1 and 2. In all six units is used advanced fuel with average
enrichment 3,82% U 235.
In 2003 Slovenske elektrarne concluded new fuel contract
with Russian Supplier for delivery of fresh nuclear fuel for Bohunice units 3
and 4 and Mochovce units 1 and 2 in period 2005 - 2010. The supplied fuel will
be of new generation (new mechanical and nuclear design with burnable Gd
absorber) and should result in better efficiency and lower annual consumption of
nuclear materials.
Management of Spent Fuel
The basic policy of spent fuel
and radioactive waste management has been established by the Resolutions No. 930/1992,
No. 190/1994 of the Slovak government.
In 1997 the Slovak government
accepted the Updated Power Policy of SE, a. s. till year 2005. The related
government Resolution No. 684/97 includes the provisions on the spent fuel
management. In 2001, the Slovak government in his Resolution No. 5/2001 accepted
”The proposal on the schedule of economical and material solution on the
management of spent fuel and decommissioning process of nuclear facilities”
and assigned to submit a ”Policy of decommissioning of nuclear facilities and
management of spent fuel elaborated according to the act on environmental impact
assessment” for a discussion on government level by 31. 12. 2007.
The current fundamental
conception of spent fuel management at SE, a. s. and in the Slovak Republic
resulting from the documents above and updated by the SE, a. s. management
remains unchanged and can be characterized as follows.
The operation of nuclear
reactors in Slovakia adopts an open fuel cycle since the reactors WWER-440 are
not licensed to utilise MOX fuel. Discharged spent fuel is stored for 3 years in
spent fuel pools of the main generation building. Further long-term spent
fuel storage (40 to 50 years after its removal from the reactor), which is
required prior to its final disposal in a repository, will be assured in
separate interim storage facilities at Bohunice and Mochovce. Reprocessing of
spent fuel from Bohunice and Mochovce NPPs is not included into the concept of
spent fuel management.
An interim spent fuel wet
storage facility (ISFS - SE-VYZ) has been in operation at Bohunice site
since 1987. ISFS - SE-VYZ has been already reconstructed in order to increase
its storage capacity. A project to enhance its seismic resistance and to improve
its safety and cooling system was accomplished in 1999. The storage facility is
re-licensed for extension of storage period to 50 years. Enlargement of the
storage capacity using new compact cask containers represents increase from
original 5 040 pcs to 14 112 pcs of fuel assemblies, which will be sufficient
for all spent fuel from Bohunice reactors produced for their whole operation
period and for Mochovce until 2015. By that time, it will be necessary to build
a new similar storage facility at Mochovce site. A project of spent fuel
storage facility at Mochovce site (ISFS - EMO) is currently in first stage of
investment preparation. According to current intentions, the facility will
probably be based on the dry storage technology.
All spent fuel assemblies from
the former A1 reactor unit (HWGCR reactor, in operation since 1973 till
1977) were transported to the Russian Federation till July 1999. Before 1987 a
small number of spent fuel assemblies from WWER-440 reactors (697 fuel
assemblies) were also transported to the Russian Federation.
Final disposal of the spent
fuel is expected to be in deep underground geological repository. Activities on
the selection of an adequate site are thus continuing.
Possibilities of transporting
the spent fuel into foreign countries for final disposal or reprocessing without
importing the products back into Slovakia and possibility of international or
regional solution on the final spent fuel disposal and new technologies in the
area of spent fuel management have to be verified.
Statistics: By the end on
2004 all Slovak VVER 440 units used 9300 fuel assemblies, from this amount
approximately 700 assemblies were exported to the Russian Federation. 6800
pieces are stored in wet interim storage facility located at Bohunice site. The
rest of about 1800 spent fuel assemblies are cooled down and stored in pools
adjacent to the reactors.
Management of Radwaste
Concerning the production of
radioactive waste in Slovakia, there are only two types of producers: power
generation companies and producers of institutional radioactive waste (research
institutes, medicine, university, industry). There are following categories of
radwaste (except spent fuel) based on its origin:
·
waste from the operation Bohunice and Mochovce NPP
·
waste related to the decommissioning A-1 NPP
·
institutional waste
The current policy of
radioactive waste management in Slovakia was approved by the Resolution No. 190/94
of the Slovak government, it can be characterized as follows:
Basic solidification
methods of liquid radioactive waste, radioactive sludge and exhausted
ion-exchanging resins into a form suitable for final disposal include
cementation and bitumenation.
The volume of solid
radioactive waste will be minimised by applying compaction and incineration.
The treated liquid or solid
radioactive waste is than grouted by active mixture of concrete and
concentrate into fibre-reinforced concrete containers. These containers are
suitable for transportation as well as for long-term storage and final
disposal.
For treatment of
intermediate level waste and radioactive waste with high contents of
trans-uranium (specific liquid radioactive waste produced during the storage
of spent fuel at Nuclear Power Plant A1 that is in form of sludge and
chrompik) is necessary to apply a vitrification method.
Low-active soil and
concrete rubble shall be arranged into layers on supervised stock-piles.
The low-activity metal
waste shall be treated by applying fragmentation and decontamination and
cleaned material can be than released into the environment.
For the treatment of metal
radioactive waste, that can not be released into the environment a melting
unit shall be installed and used for its conditioning.
Institutional radioactive
waste shall be treated and conditioned into a form acceptable for final
disposal. Waste of open source character will be conditioned by applying
standard methods. The disused sealed sources shall be conditioned into a
form suitable for centralised long-term storage or disposal.
The conditioned radioactive
waste produced during the operation and decommissioning of nuclear power
plants and the conditioned institutional radioactive waste that meet the
acceptance criteria shall be disposed of in the National Repository Mochovce.
The waste which is not
acceptable for the National Repository Mochovce shall be stored at the power
plants. An integral storage shall be installed at Bohunice to allow storing
of radioactive waste that is not acceptable for NRR.
An integral storage for
disposal of the radioactive waste which does not meet the criteria for
disposal in near surface repository do not represent the final solution.
Therefore for disposal of mentioned “non acceptable” waste a deep
geological repository shall be built.
In 1996 the new plant -
subsidiary of SE, joint stock company, marked SE- VYZ was established
to ensure and perform activities concerning Decommissioning of the Nuclear
Facilities and Radioactive Waste and Spent Fuel Management.
The following technologies for
radioactive waste treatment and conditioning in frame of the VYZ company are
currently available, certified for permanent operation:
Bohunice Radwaste Treatment
Center
Bitumenation plants
Active waters purification
plant
Vitrification plant
Facility for fragmentation
of metal waste
Bohunice Radwaste Treatment
Center is designed to process and treat liquid and solid radioactive waste
arising from the NPP A-1 decommissioning, from NPPs V-1, V-2 in Jaslovske
Bohunice and Mochovce as well as institutional radwaste of diverse
institutions in the Slovak republic. The final product, cemented radwaste into
the fibre reinforced concrete (FRC) containers from Bohunice Radwaste Treatment
Center are being transported to the National Repository for final storage and
safe long-time isolation radwaste from environment.
Commencement of commercial operation of Bohunice
Radwaste Treatment Center was on February 2000, based on Regulatory body
Decision No.416/99.
The Bohunice Processing Center processes RAW which
can be classified into the following categories:
·
combustible solid and liquid waste,
·
pressable solid waste,
·
non-combustible and non-pressable waste,
·
concentrates,
·
ionex resins (sludges)
·
other contaminated liquids and sludges.
This center includes the
following technologies for processing and treatment of RAW:
·
sorting,
·
compacting (press plant.)
·
incineration,
·
concentration, (evaporator)
·
cementation facility into FRC containers
·
emission monitoring
·
transport
Radioactive Waste Storage
The National Radwaste
Repository, located near the Mochovce NPP, is a near surface facility designed
for the disposal of solid and solidified low and intermediate-level radioactive
waste. The capacity of the two double-rows (80 storage boxes) is 7200 FRC
containers of radioactive waste (produced by operation and decommissioning of
NPP A-1 and institutional waste). Since the disposal of all others radioactive
waste (from decommissionig of EBO and EMO NPPs), the National Radwaste
Repository needs to be extended. The site layout enables to extend the capacity
up to 10 double-rows.
Commencement of commercial
operation of National radioactive waste repository, Mochovce was on October
1999, based on Regulatory body Decision No.335/99.
Other radioactive waste storage
facilities are located in site of Bohunice NPP. At present a few empty
compartments inside NPP A-1 have been reconstructed into the storage facilities
licensed particularly as the individual nuclear facility. Various solid and
solidified waste streams (mostly in 200 l drums) are stored here awaiting their
final fixation into standard containers on Bohunice Waste Treatment Center.
It is intended to construct
new storage facilities to storage treated radwaste non acceptable for the
National radioactive waste repository, Mochovce. The project preparation has
been started (EA study).
Operation of nuclear facilities
for spent fuel storage and RAW treatment and disposal
The treatment and storage of
radioactive wastes produced in the Slovak Republic is performed in compliance
with the legislative and procedures developed by the Nuclear regulatory
authority. Operation of all treatment and storage radwaste nuclear
facilities is licensed and regularly supervised by the state regulatory body.
The work during all process of
radwaste handling is organized so as to prevent unnecessary irradiation of the
staff (ALARA principle).
It could be stated, that the
radwaste handling facilities in the Slovak republic, all operated by
Slovak Electric Power Company have no significant impact on the radiation
situation of the NPP surroundings.
Material and Financial
Provision of Radwaste Management
The new plant, subsidiary of SE
company, marked VYZ established in 1996, is being responsible for
Decommissioning of Nuclear Power Installations and Radioactive Waste and Spent
Fuel Management. Besides that, the SE-VYZ plant will provide the disposal of
institutional radwaste from other organizations. The plant activities are being
financed from the SE utility budget and from the State Fund for Decommissioning
of Nuclear Power Installations and Radioactive Waste and Spent Fuel Management.
The State Fund was established
by the Act No. 254/1994 Coll. with effect from 1 January 1995. Mentioned Act was
afterwards amended by the following acts: Act No. 78/2000 Coll. and Act No.
560/2001 Coll. The main aim of amendments was especially modification how to
create and use the resources of the Fund.
The Ministry of Economy of the
administers the Fund and the fund resources are controlled on the special
account in the National Bank of Slovakia.
By the mentioned act the
sources of the Fund shall be generated from:
a)
contributions by nuclear installation operators,
b)
penalties imposed by Nuclear Regulatory Authority of the Slovak Republic upon
natural persons and legal entities pursuant to separate regulation
c)
bank credits
d)
interest on Fund deposits in banks
e)
grants from State Budget
f)
other sources as provided by special regulation.
The basic resources of the Fund
are contributions of operators of nuclear facilities. In compliance with above
mentioned act, operator of nuclear facility is obliged to contribute yearly to
the Fund the sum 350 000 Sk for each megawatt of installed electric power
of the nuclear facility and 6,8 % from sales price of electric power generated
yearly in the nuclear facility.
The Fund Council as his
advisory body has been appointed by The Minister of Economy for generation and
utilization of Fund resources.
It is possible to provide
resources of the Fund as specific subsidy to the operator of nuclear facility or
spent fuel and radioactive waste repository and to the person determined for the
management of orphan sources on the basis of written application accompanied by
the project with technical and economic reasoning.
It is possible to use the Fund
resources for:
a)
decommissioning of nuclear facilities,
b)
management of spent fuel and radioactive waste after the end of nuclear facility
operation (where were originated),
c)
management of orphan sources and waste from illicit trafficking when originator
is unknown,
d)
purchase of site for spent fuel and radioactive waste repositories,
e)
research and development in the area of decommissioning of nuclear facilities
and management of spent fuel and decommissioning radioactive waste,
f)
investigation of sites, geological survey, design, construction, commissioning,
operation and closure of spent fuel and radioactive waste repositories
including monitoring after their closure,
g)
expenses related to the Fund activities up to 0,3 % of annual income of the
Fund,
h)
contributions on protection of life and health of population in the hazard area
of nuclear facility.
The resources of the State Fund
have been formed since 1995. The generation of NPP A-1 finished in 1977,
therefore no resources from NPP A-1 have been created. NPP V-1 shall be untimely
shutdown, so the contributions from NPP V-1 will not be sufficient for
decommissioning. That is why accumulated financial resources into Fund will not
be sufficient to build a deep geological repository for high level radioactive
waste and spent fuel elements. At the present time the analysis, models and
possibilities of the Fund creating are being worked out, to be sufficient for
all fuel cycle back-end in Slovakia. Based on the new Act on State Fund is being
preparing to resolve the issue of financing of NPP A-1 and NPP V-1
decommissioning.
2.6. Research and Development
2.6.1
The research and development organizations and
institutes
The research and development
activities in Slovakia are based on national long-term strategic plans
transferred into medium-term projects, which reflect country specific conditions
and needs of the utilization of nuclear energy in Slovakia. The strategic plans
and projects are bound to international research and development activities,
particularly those conducted within EU countries or OECD/NEA.
The research and development in
Slovakia is financed from the state budget completed by funds from private
sector or support from EU. The expenditures to research and development in
Slovakia are limited. They represent several hundred thousands USD per year.
Utility’s technical support
organizations and universities initiate the research and development. The
activities are focused on effective and efficient use of nuclear fuel, efficient
conversion of nuclear energy into heat and electricity, treatment and disposal
of radioactive materials and spent fuel, improvement and validation of
analytical computer codes, emergency preparedness and panning, and in support of
safety enhancement of nuclear facilities. The Slovak regulatory body initiates
the research and development work where it considers that there is a need for
additional studies beyond those undertaken by utilities or it can apply to
suitable critical considerations in its review and assessment.
The organizations, which conduct
the research and development in Slovakia, are:
·
VUJE, Trnava
·
VUEZ, Levice
·
DECOM Trnava
·
Relko, Bratislava,
·
Slovak Technical University, Bratislava, and others.
2.6.2
Development of advanced and new generation
nuclear reactor systems
Slovakia
has not developed any advanced nuclear reactors. Engagement of national
companies in the development of advanced nuclear reactor systems is limited and
performed in co-operation with foreign companies on commercial basis.
2.7. International Co-operation and Initiatives
Co-operation of the Slovak Republic with the IAEA on technical projects has
been highly successful. In 2004 co-operation was going on with four national,
many regional and interregional projects by participations in workshops,
training courses and technical meetings (app. 55 participants), by providing
technical assistance of experts and supply of equipments as well as through
coordinated research projects.
32 external experts from regulatory bodies and nuclear power plants from
Lithuania, Georgia, Philippines and Pakistan were trained in the Slovak
Republic. Training and consultations were focused mainly on issues of
nuclear and radiation safety, radioactive waste management, legislation, safety
analyses and operation of nuclear power plants, their decommissioning and
lifetime extension.
Slovak experts prepared number of various documents that serve as supporting
materials for evaluations and technical publications of the OECD/NEA. The Slovak
republic participated in activities of the HALDEN Reactor Project and on
activities of MASCA-2 Project (from the year 2004).
Representatives of Slovakia took part regularly in meetings of committees and
working groups of the European Commission an the Council. They monitored and
presented positions in respective areas regarding preparation of the new EU
legislation.
One of the most important working group, taking into account responsibilities
of UJD, is Atomic Questions Group (AQG) in which comprehensive
discussions have been realised in connection in connection with “Nuclear
Package” included two proposals of directives on subject of nuclear
safety of nuclear installations and safety of spent fuel and radioactive waste
management.
More information isavailable in the Annual Report of the Nuclear Regulatory
Authority (www.ujd.gov.sk).
3. NATIONAL LAWS AND REGULATIONS
3.1. Safety Authority and the Licensing Process
Licensing procedures have three main levels: selection of construction site, commencement of construction and permanent operation. Prior to issuing a license for permanent operation, the regulatory authority performs inspections in line with the approved programmes of active and non-active tests and issues approvals for fuel loading, physical start-up, power start-up and trial operation. The major regulatory authorities and the process of licensing procedures are shown in Figure 10.

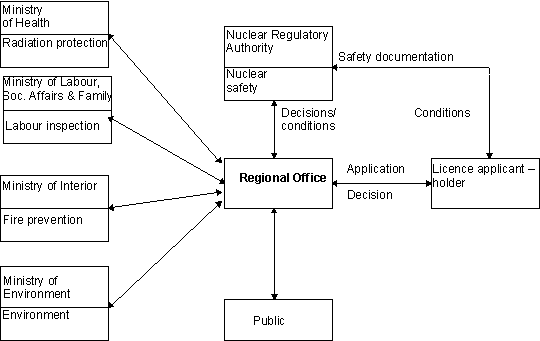

FIG. 10. Licensing procedures |
The basic mandatory condition
for issuing any approval related to nuclear safety is to develop and submit a
Safety Analysis Report and other prescribed safety documentation and to comply
with the conditions from previous approval proceedings and with the decisions of
the regulatory authority. The regional construction offices issue decisions for
the selection of construction site of nuclear installations based on the
approval of the Nuclear Regulatory Authority, Ministry of Health and of other
offices and organizations of state authorities. Nuclear Regulatory Authority
since 1-st December 2004 is special construction authority for final decision
for construction, operation and decommissioning of nuclear installations As
regards approvals, responsibilities of these authorities are specified in the
law No. 50/1976 (Construction Law), in Act No. 541/2004 and in
regulations of the Ministry for Environment Nos. 453/2000 and 55/2001. The
licensee is responsible for the safety of its nuclear installation.
The Nuclear Regulatory Authority (ÚJD) of the Slovak
Republic is a follower of the former Czechoslovak Atomic Energy Commission. It
was established on 1 January 1993 and its rights result from the Law No. 2/1993
of the Slovak National Council. This act was replaced by Act No. 575/2001,
effect since 1 January 2002. The ÚJD is an independent state regulatory
authority reporting directly to the government and its chairman is appointed by
the cabinet. As of 1 January 2004, ÚJD staff amounted to 81 employees.
The organizational structure is shown in the Figure 11.

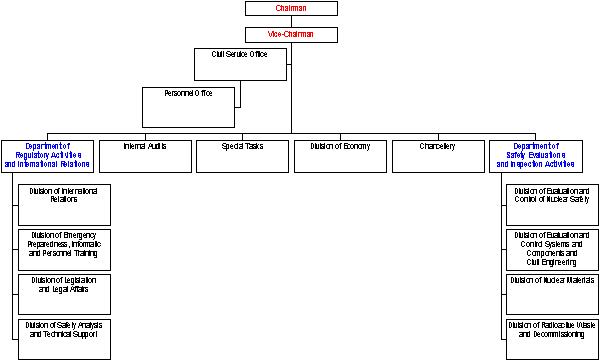

Fig. 11. Organizational Structure of the Nuclear Regulatory Authority ÚJD SR |
The ÚJD SR Chairman is appointed by the government and
co-operates with other central bodies of the state authorities in performing his
activities, and he submits regularly to the Slovak government reports about the
safety of nuclear installations in Slovakia and about his activities. Since 1
January 2002 also vice-chairman is appointed by the government and the proposal
by the chairman.
The
ÚJD SR executes the state regulation over:
i)
nuclear safety of nuclear installations including the regulation over the
management of nuclear waste, spent nuclear fuel and other phases of nuclear fuel
cycle;
ii)
nuclear materials including their control and recording;
iii)
quality of selected equipment and instrumentation.
The
ÚJD SR ensures:
i)
review of intentions how to use nuclear energy in respect on nuclear safety;
ii)
evaluation and inspection of emergency plans;
iii)
fulfilment of the commitments of the Slovak Republic resulting from
international agreements in the field of nuclear safety and nuclear material
safeguards.
The
execution of nuclear regulation is supported by laws, especially in the law No.
541/2004 and in several regulations that give to the authority high powers
including the acceptance of such measures as requirements on safety improvement,
as well as orders for power reduction or reactor shut-down if required by safety
reasons. Former regulations issued according to Act No. 130/1998 were canceled
by new Atomic Act No. 541/2004. The new 13 regulations are under preparation.
According
to the law No. 541/2004, the ÚJD SR performs:
i)
routine inspections by site inspectors;
ii)
special inspections by nuclear safety inspectors;
iii)
team inspections.
The routine inspections are executed according to standard
procedures developed for the particular inspections. The special and team
inspections are executed according to programs developed for the particular
inspection. These programs are sent in advance to the organization in which the
inspection is to take place. The inspectors write down protocols about the
inspections performed. The inspections are performed in line, with an inspection
plan and programme of quality assurance and inspection activities as Appendix.
The authority has been established in line with international recommendations as
was confirmed by a number of expert missions of the International Atomic Energy
Agency and the European Commission. Work contacts with partner regulatory bodies
in all European countries with nuclear power developed, but also in the U.S.A
and Japan, contribute significantly to improving the work quality of the ÚJD
SR.
On June 14, 2001, the Act No. 276/2001 on the
regulation in network industries and on amendments in certain other laws was
approved by the Slovak National Council. The bill specifies:
A) establishment, authority and
activities of the Office for Regulation of Network Industries;
B) object and conditions of the
state regulation in network industries; and
C) conditions for the execution of regulated
activities and rights and obligations of regulated subjects.
The Office for Regulation of Network Industries was
established as from 1 August 2001 and is currently under development.
Relevant provisions of Act No. 276/2001 were replaced by
Act No. 656/2004 on power engineering and on alteration in certain acts which is
in force since 1st January 2005.
3.2. Main National Laws and Regulations in Nuclear Power
• The Act No. 575/2001 Coll. On government organization,
central state administration
The most important part of the UJD SR legislative activity
in 2004 was preparation of the Act no. 541/2004 Coll. on Peaceful use of nuclear
energy (”Atomic Act”) and on amendment and alterations of several acts which
was adopted by the National Council of Slovak Republic on September 9, 2004 and
it is in force of December 1, 2004. The Act is fully in compliance with the
EU legislation.
The new regulations according to act 541/2004 Coll. are under preparation.
The following regulations have been adopted according to
the mandate formulated in the former act 130/1998 Coll. They were in force till
November 30, 2004.
•
ÚJD SR Regulation No. 29/1999 which includes list of special materials and
equipment.
• ÚJD SR Regulation No. 30/1999 that specifies details
about the maximum limiting amounts of nuclear materials for which occurrence of
nuclear damage is not assumed.
• ÚJD SR Regulation No
29/1999
Coll on list of special (dual - use) materials and
components
(effective from 1-st March 1999)
• ÚJD SR Regulation No
30/1999
Coll on maximum quantities of
nuclear materials excluded from Vienna Convention
(effective from 1-st March
1999).
• ÚJD SR Regulation No
186/1999
Coll which defines details on
ensuring physical protection of nuclear facilities, nuclear materials and
radioactive wastes
(effective from 1-st August 1999).
• ÚJD SR Regulation No
187/1999
Coll on training and
qualification of personnel of nuclear facilities
(effective from 1-st August 1999)
• ÚJD SR Regulation No
198/1999
Coll on accounting for
control of nuclear materials
(effective from 1-st September 1999).
• ÚJD SR Regulation No
245/1999
Coll on emergency planning
for the case of incident or accident
(effective from 1-st October 1999).
• ÚJD SR Regulation No
246/1999
Coll on documentation of
nuclear installations at decommissioning
(effective from 1-st October 1999).
• ÚJD SR Regulation No
284/1999
Coll on the details of
transport of nuclear materials and radwaste
(effective from 15-th November 1999).
• ÚJD SR Regulation No
31/2000
Coll on events at nuclear
installations
(effective from 15-th February
2000).
• ÚJD SR Regulation No
190/2000
Coll by which details of
radioactive waste management and spent fuel management are regulated
(effective from 1-st July
2000).
• ÚJD SR Regulation No
317/2002
Coll on requirements on
quality systems of the authorization holders as well as on alteration and
amendment of the Decree of the Nuclear Regulatory Authority of the Slovak
Republic No. 187/1999 Coll. on nuclear installation personnel competence
(effective from 1-st July
2002)
• ÚJD SR Regulation No
318/2002
Coll on the Safety
Documentation of Nuclear Installations and on Alteration and Amendment of the
Decree of the Nuclear Regulatory Authority of the Slovak Republic No. 245/1999
Coll. on the Emergency Planning in Case of an Incident or Accident
(effective from 1-st July
2002)
• ÚJD SR Regulation No
121/2003
Coll on nuclear safety
assessment
(effective from 1-st June
2003)
• ÚJD SR Regulation No
167/2003
Coll on requirements for
nuclear safety of nuclear installations
(effective from 1-st
June 2003)
The new 13 regulations
according to new Atomic Act No. 541/2004 are under preparation. It will be
session on permanent working group on Legislative council of the Government for
technical legal documents on 10 August 2005.
• The law No. 276/2001 on
the regulation in network industries and on amendments in certain other laws was
approved by the Slovak National Council
The Act No. 656/2004 on power
engineering and on alterations in certain acts
SAFETY GUIDES OF ÚJD SR
Following safety guides were elaborated during 1995 - 2005:
BNS
I.12.1/1995 |
Requirements
to assure quality of computers information software |
BNS
I.11.1/1995 |
Requirements
on safety analysis elaboration |
BNS
I.4.2/1996 |
Use
of PSA methodology in the process of regulation by regulatory authority |
BNS
I.4.1/1999 |
Single
failure criterion |
BNS
I.9.1/1999 |
Safety
of nuclear facilities during decommissioning |
BNS
I.11.2/1999 |
Requirements
for performance of safety analyses for ATWS |
BNS
III.4.1/2000 |
Requirements
on UJD SR permit issue for fuel use in VVER 440 reactors |
BNS
III.4.3/2000 |
Requirements
on assessment of fuel loading for VVER 440 reactors |
BNS
I.2.6/2000 |
UJD
SR requirements on chapt. 4 of Safety analysis report "Core
design" |
BNS
II.3.1/2000 |
Evaluation
of acceptability of faults detected during the operation inspection of
nuclear installation selected equipment |
|
|
BNS
II.5.1/2002 |
Welding
at nuclear power installations (NPI). Basic requirements and rules |
BNS
II.5.2/2002 |
Supervision
of the welding quality at NPI. Requirements |
BNS
II.5.3/2002 |
Requirements
on welding additives at NPI |
BNS
II.3.1/2003 |
Evaluation
of acceptability of faults detected during the operation inspection of
nuclear installation selected equipment |
BNS
I.2.6/2001 |
Quality
assurance of safety documentation. Basic requirements and rules |
BNS
II.2.1/2001 |
Requirements
on fire safety assurance of nuclear power plants in view of nuclear safety |
BNS
I.9.2/2001 |
Ageing
management of nuclear power plants. Requirements– Požiadavky |
BNS
II.5.1/2003 |
Welding
at nuclear power installations. Basic requirements and rules |
BNS
II.5.2/2003 |
Supervision
of welding and quality of welded joints at nuclear power Installations-
requirements |
BNS
II.5.3/2003 |
Welding
materials for welding at nuclear power installations,technical
requirements and rules of choice |
BNS
I.9.1/2003 |
Safety
of nuclear facilities during decommissioning |
BNS
I.11.2/2003 |
Requirements
for performance of safety analyses for ATWS |
BNS
I.12.1/2003 |
Requirements
to assure quality of computers information software |
BNS
II.3.3/2004 |
Metallurgical
products and spare parts for nuclear power plants |
BNS
III.4.4/2004 |
Requirements
for realization and evaluation of results of physical tests in start-up
process |
BNS
II.5.4/2004 |
Qualification
of the systems for non-destructive testing in a nuclear power generating
field |
BNS
I.2.5/2005 |
UJD
SR requirements on chapt. 16 of Safety analysis report "Limits and
Conditions" |
BNS
I.8.1/2005 |
Reqiurements
on physical protection of nuclear installation and nuclear materials |
IV.1.3/2005 |
Requirements
on nuclear spent fuel storage design and operation |
4. CURRENT ISSUES AND DEVELOPMENTS ON NUCLEAR POWER
4.1. Energy Policy
Role
of the government in the nuclear research and development
The government creates conditions, establishes
legislative framework and supports research and development in Slovakia. It
works out strategic plans and outlines main directions for research and
development supported. The government co-ordinates research and development
activities in the country and links them to foreign activities. Keeps the
records and statistics.
Nuclear
energy and climate change
Roughly 80% of the world energy is currently
obtained from fossil fuels. However their supplies will have been used up over a
certain time, apart from them being irreplaceable in the chemical industry,
which will also better appreciate them. Assuming the current annual production,
oil supplies are estimated at 45 years, as are gas supplies at 70 years, and
coal supplies at 250 years. Moreover, fossil fuels burden the environment with
not only sulphur and nitrogen oxides, but in particular with CO2, which causes
global warming, and thereby also climatic changes on the globe. The Earth´s
average temperature over the last 100 years has risen by 0.6°C; it is expected
to increase in the next century by 1.5 up to 3,5°C, some experts even state 2-5°C.
The global problem such as climatic changes calls for a global solution. This
has been attempted by the conference in Kyoto, Japan, however unsuccessfully,
where merely partial solutions have been proposed. These proposals only apply to
OECD countries and the former Soviet bloc´s countries. The limitations do not
concern the countries where a critical increase in greenhouse gases (GHG) is
expected, i.e. developing countries. These states inevitably need increasingly
higher amounts of energy for their development, and these will be acquiring it
from a source best available to them, hence coal. However coal combustion has
the most environmental impact of all the fossil fuels. Europe and North America
have increasingly shifted away to natural gas, which however the developing
world cannot afford because of high prices of the fuel. In burning gas CO2 also
forms, albeit there is roughly 40% less of it than in burning coal.
While SE, a.s. contributes as much as nearly 84% to Slovakia´s total
electricity generation, it cannot be deemed a major CO2 producer.
SE, a.s. relatively low contribution to the country´s CO2 emission production
(about 13%) follows particularly from SE, a.s. advantageous structure of
generation facilities. In 2003 as much as 69% of electricity was generated at
nuclear power plants. The generation contribution by hydro power plants and
fossil power plants came to 18% and 13%, respectively.
Safety
and waste management issues
Waste management issues
In point of waste management, the most significant
issue, that must be resolved in next time, is the final disposal of
spent fuel and high level radioactive waste. As it was mentioned the final
disposal is expected to be in deep underground geological repository.
The preparing phase (it means a couple of studies)
of the project for development of deep geological repository for high level
radioactive waste and spent fuel elements was begun in 1996 and all activities
inside the project have been ordering by the SE, company until present time.
According the plan of project, it is intended to
finish the sitting process after 2010, and to accept the first spent fuel
containers for disposal after 2037.
Other
current issue concerning radwaste is solution of liquid radioactive waste
arising from operation of NPP Mochovce. Based on the project the generating
liquid waste after conditioning (mainly evaporation is collected in projected
operational tanks. The project for final treatment of liquid radioactive waste
arising from operation of NPP Mochovce has been started since 2002.
The latest issue of the same significant meaning, that will be solved during
next years, is the preparation of new storage facility to storage treated
radwaste non acceptable for the Mochovce National radioactive waste repository.
Regarding waste management issues, one of the most important point is
establishing of new State Agency for radwaste storage resulting from Atomic Law.
There were a couple negotiations addressed to this issue between Ministry of
Economy , Nuclear Regulatory Authority and SE since 2000.
In 2003 was submitted to EU the project “Technical support to the Slovak
Republic in establishing the national agency for radioactive waste
management”.
Safety
issues
Following safety related issues could be currently or for the near future
identified as regards Slovenské elektrárne, a.s.:
· continuation and
successful completion of Bohunice V-2 modernization and safety upgrading
program, according to the schedule and requirements of regulatory authority;
· maintaining safety level
of all Slovak nuclear units on the deregulated energy market and during ongoing
process of restructuring and privatization of SE;
· maintaining safety level
of Bohunice V-1 units till the end of their operation in 2006 and 2008
respectively;
· development and
implementation of SAMGs at Bohunice V-2 and Mochovce NPPs;
· preparation and
execution of periodic safety review of:
o Bohunice V-2 after
further 10 years of operation (since last updated SAR, which was elaborated in
1996)
o Mochovce NPP after
ten years of operation.
REFERENCES
[1] | Annual Report ÚJD SR 1995. |
[2] | Annual Report SE Inc 1995. |
[3] | The Power Concept for Slovakia Till 2005. |
[4] | The Slovak Nuclear Power in 1995. |
[5] | Slovakia - National Survey Paper 1995. |
[6] | Annual Report Statistical Office of the Slovak Republic 1995. |
[7] | Data from EGU State Enterprise, Inco Inc. and NPP State Enterprise |
[8] | KOSTICKY, B., LIPÁR, M.: The first product of nuclear era, OSVETA (1987). |
[9] | KOSTOVSKÝ, K.: Twenty years of nuclear power in Slovakia, ALFA (1993). |
[10] | SLÁDEK, V.: Power plant industry in Slovakia 1920-1994, ALFAPRESS (1996). |
[11] | ANNUAL REPORT of VÚJE Trnava Inc. |
[12] | ANNUAL REPORT of SE Inc (1998). |
[13] | ANNUAL REPORT of SE Inc (2000). |
[14] | Statistical Yearbook of the Slovak Republic 1998. |
[15] | Data & Statistics/The World Bank, www.worldbank.org. |
[16] | IAEA Energy and Economic Data Base (EEDB). |
[17] | IAEA Power Reactor Information System (PRIS). |
Appendix 1
INTERNATIONAL (MULTILATERAL AND BILATERAL) AGREEMENTS
AGREEMENTS WITH THE IAEA |
||
NPT related safeguards agreement |
Entry into force by Czechoslovakia: |
28 December 1972 |
Additional Protocol |
Signed |
27 September 1999 |
Improved procedures for designation of safeguards inspectors |
Accepted |
|
Revised supplementary agreement on provision of technical assistance by the IAEA |
Entry into force: |
4 October 1995 |
Agreement on privileges and immunities |
Succession: |
27 September 1993 |
OTHER RELEVANT INTERNATIONAL TREATIES etc. |
||
NPT |
Succession: |
1 January 1993 |
Treaty on the prohibition of the emplacement of nuclear weapons and other weapons of mass destruction on the sea bed and the ocean floor and in the subsoil their off |
|
|
Convention on physical protection of nuclear material |
Entry into force: |
1 January 1993 |
Convention on early notification of a nuclear accident |
Entry into force: |
1 January 1993 |
Convention on assistance in the case of a nuclear accident or radiological emergency |
Entry into force: |
1 January 1993 |
Vienna convention on civil liability for nuclear damage |
Entry into force: |
7 June 1995 |
Joint protocol |
Entry into force: |
7 June 1995 |
Protocol to amend the Vienna convention on civil liability for nuclear damage |
Not signed |
|
Convention on Supplementary compensation for nuclear damage |
Not signed |
|
Convention on nuclear safety |
Entry into force: |
24 October 1996 |
Joint convention on the safety of spent fuel management and on the safety of radioactive waste management |
Entry into force: |
18 June 2001 |
ZANGGER Committee |
Member |
|
Nuclear Export Guidelines |
Adopted |
|
Acceptance of NUSS Codes |
Summary of reply received from Czechoslovakia: Codes are appropriate for formulating and implementing national requirements. They are used for that purpose |
|
Nuclear Suppliers Group |
Member |
|
BILATERAL AGREEMENTS
Appendix 2
DIRECTORY OF THE MAIN ORGANIZATIONS, INSTITUTIONS AND COMPANIES INVOLVED IN NUCLEAR POWER RELATED ACTIVITIES
NATIONAL ATOMIC ENERGY AUTHORITY | |
Nuclear Regulatory Authority (UJD SR) |
Tel: +421-2-53421 032 |
OTHER MINISTRIES |
|
Ministry of the Environment |
|
OTHER NUCLEAR ORGANIZATIONS |
|
Slovak Electric (SE) |
Tel: +421-2-5069 3252 |
Affiliations: |
Tel: +421 33 555 2201 |
- Decommissioning of Nuclear Power |
Tel: +421 33 555 6101 |
- NPP Mochovce |
Tel: +421 36 639 1164 |
Slovak Power Inspectorate Power Agency |
Tel: +421 2 5824 8345 |
Occupational Safety Office of the Slovak Republic |
Tel: +421-2-326 42 3 |
RESEARCH AND DEVELOPMENT ORGANIZATIONS |
|
VÚJE Trnava, Inc. - |
Tel: +421-33 599 1356 |
Research Institute of Welding (VUZ) |
Tel: +421-2-4924 6200 |
Research Institute of Cables and Insulating Materials (VUKI) |
Tel: +421-2-5556 1447 |
Power Equipment Research Institute (VÚEZ) |
Tel: +421-36-6312 055 |
Power Research Institute (EGU) |
Tel: +421-2-5824 8435 |
Institute of Preventive and Clinical Medicine (UPKM) |
Tel: +421-2-5936 9111 |
CSA and EBO |
Tel: +421-33-5521 052 |
National Institute of Hygiene and Epidemiology. |
Tel: +421-2-4437 2287 |
DECOM |
Tel: +421-33-5521 074 |
VUPEX |
Tel: +421-2-5342 1037 |
RELKO |
Tel: +421-2-4446 0138 |
ALLDECO |
Tel: +421-33-559 2431 |
MERIT |
Tel: +421-33-544 1037 |
Institute of Radioecology |
Tel: +421-55-6323 537 |
Slovenské energetické strojárne (SES) |
|
UNIVERSITIES |
|
Slovak Technical University (STU) |
|
Faculty of Electric-Technology & Information (FEI) |
Tel: +421-2-6029 1111 |
Faculty of Chemical Technology (ChTF)
Radlinského 9 |
Tel: +421.2-5932 5111 |
Comenius University Bratislava (KU): |
|
Faculty of Mathematics, Physics and Informatics |
Tel: +421-2-6542 5946 |
Faculty of Natural Sciences (PdF) |
Tel: +421-2-6029 6111 |
P.J. Safarik University Kosice |
|
Technical University of Bratislava |
|
OTHER ORGANIZATIONS |
|
Institute of Physics Slovak Academy of Sciences (SAV) |
Tel: +421-2-392 751 |
Hospital - Oncology Institute of St. Elizabeth (OUSA) |
Tel: +421-2-5924 9111 |
Slovak Metrological Institute |
